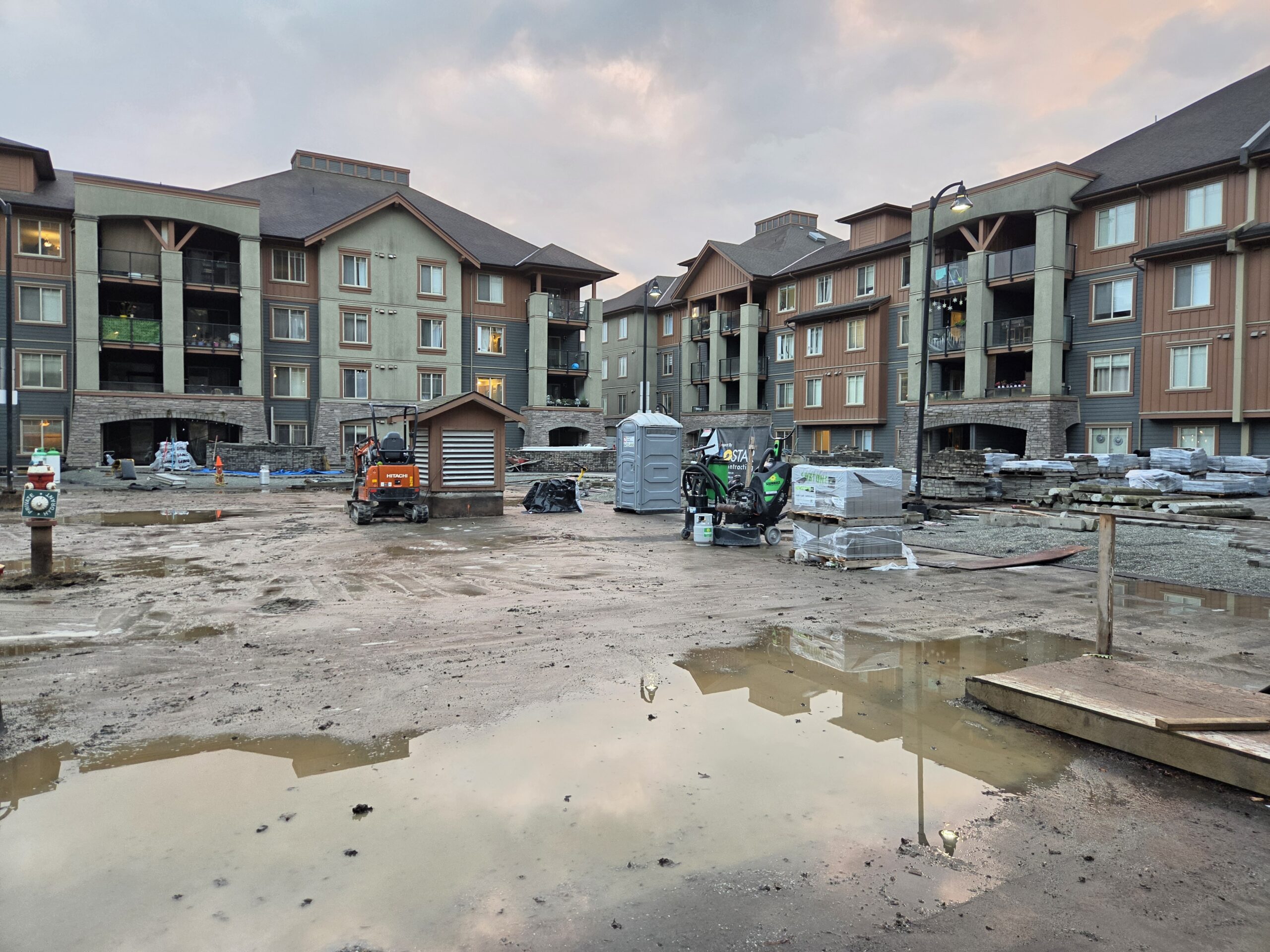

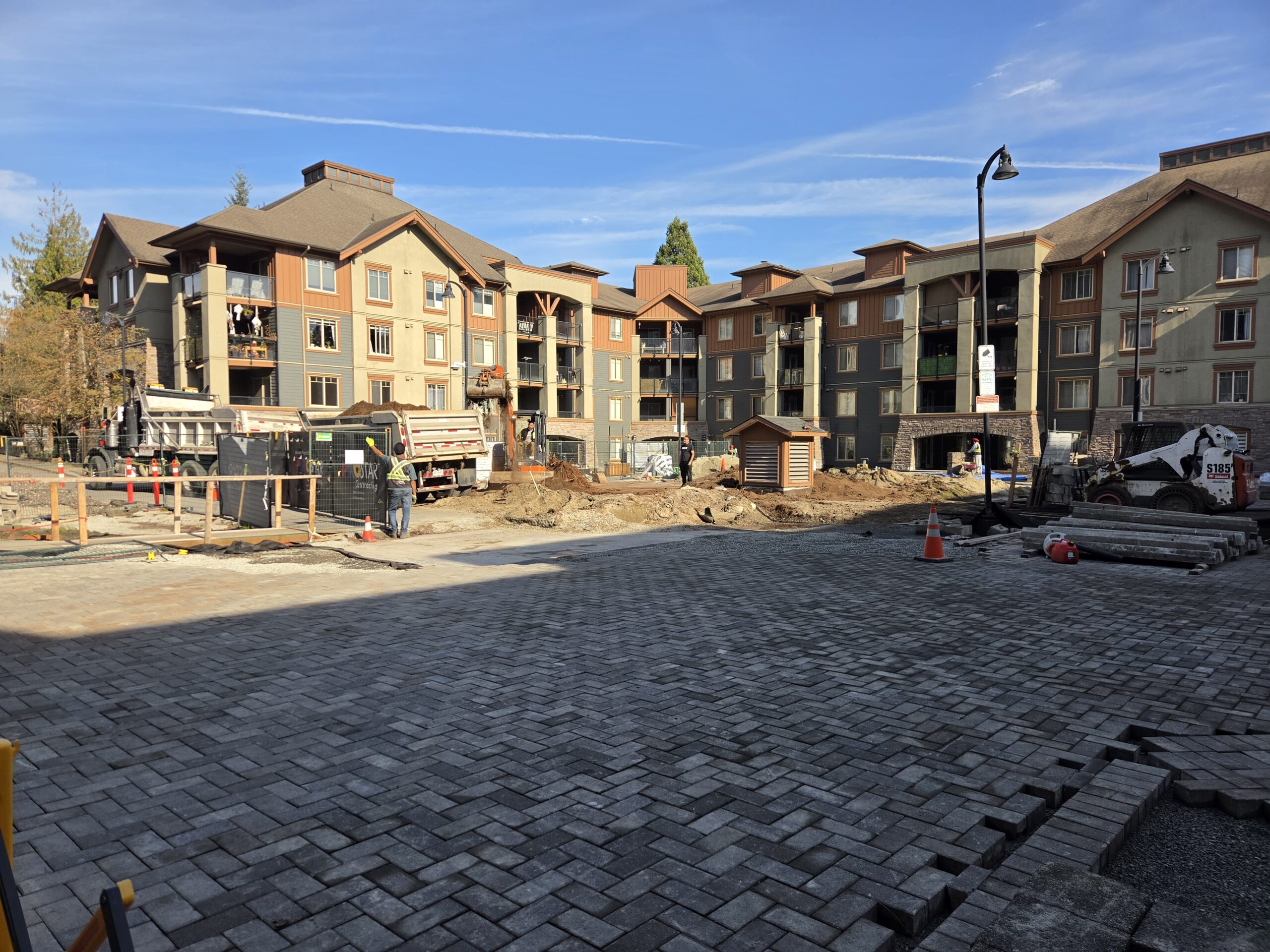

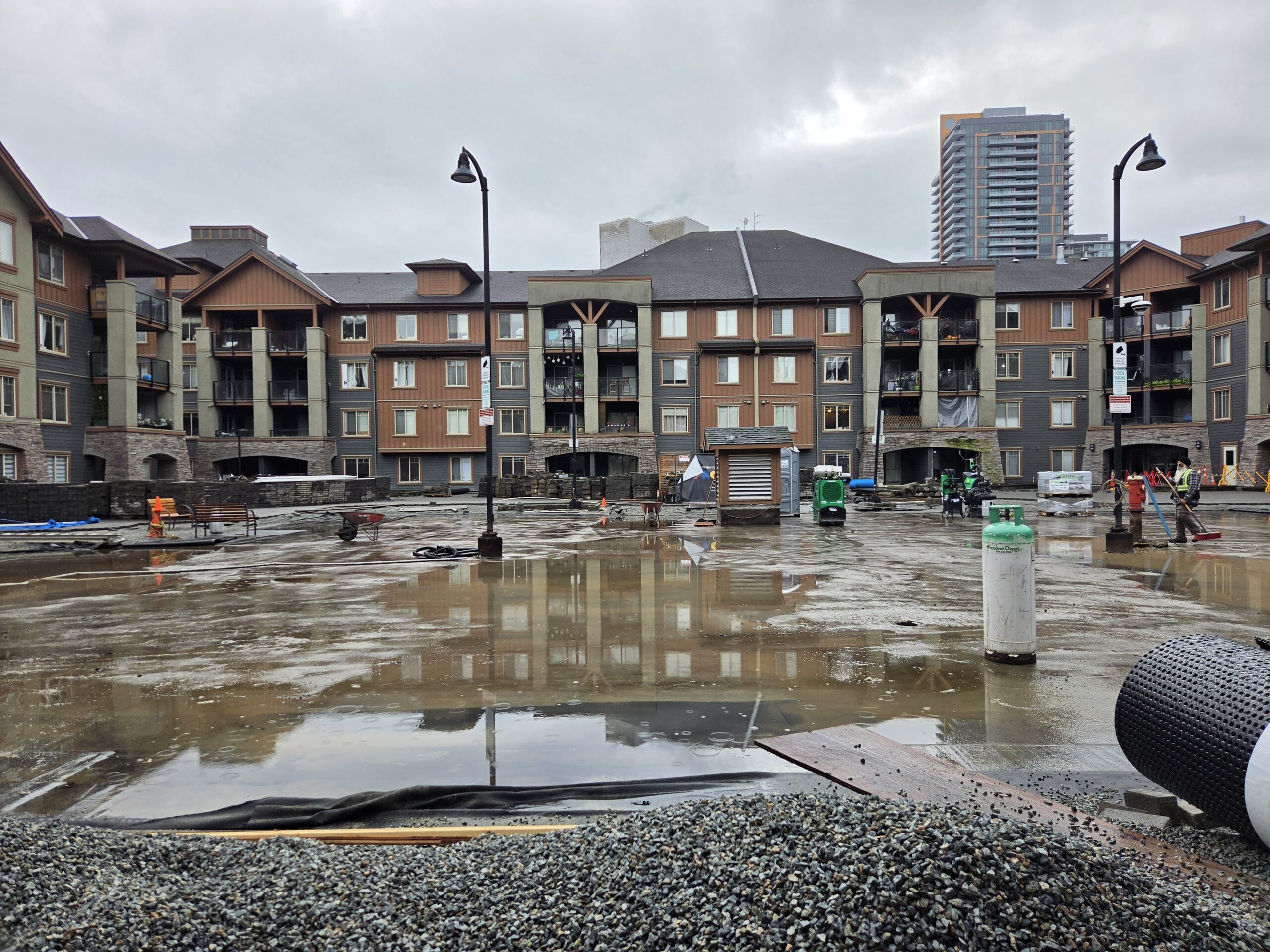

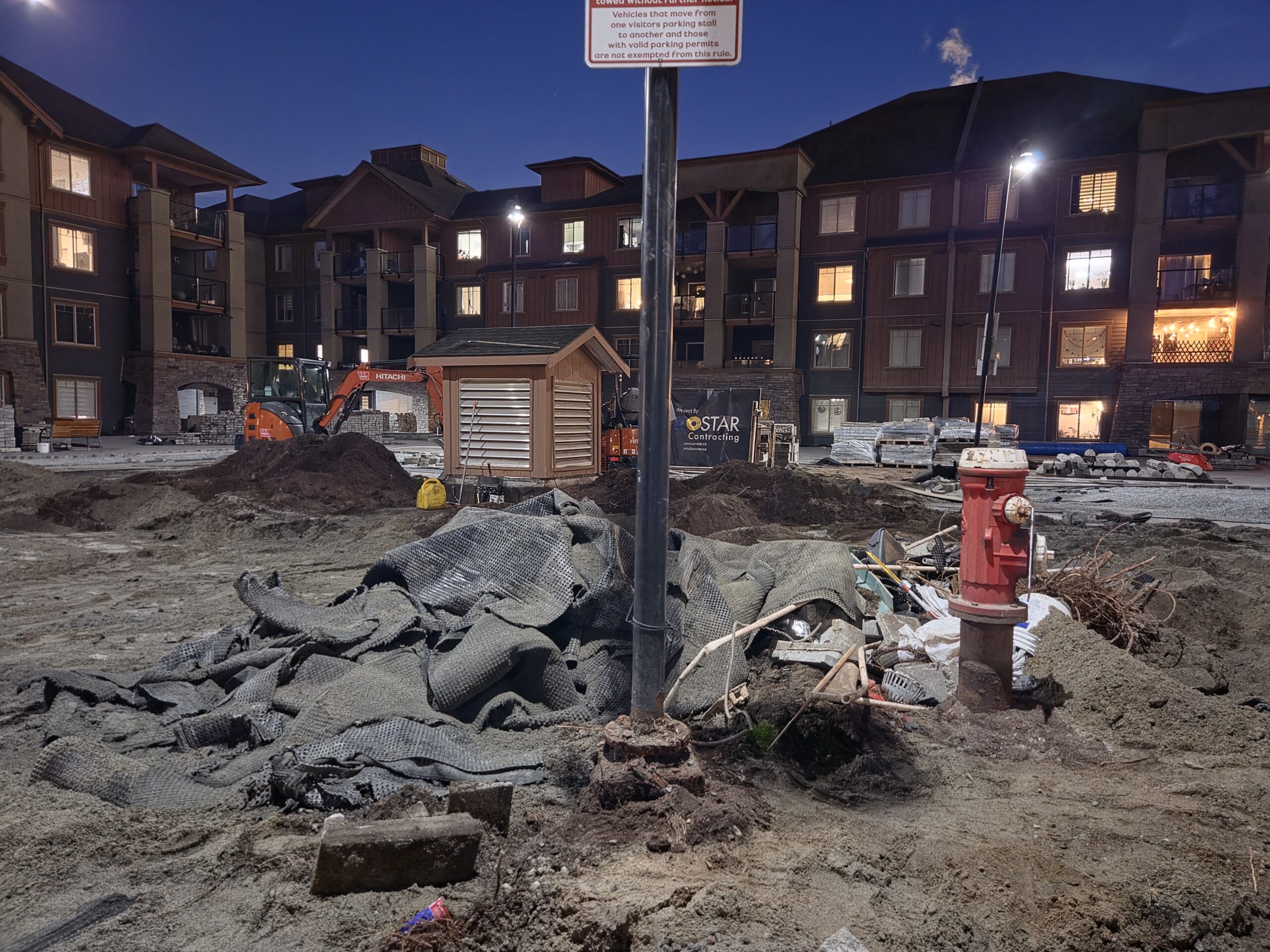

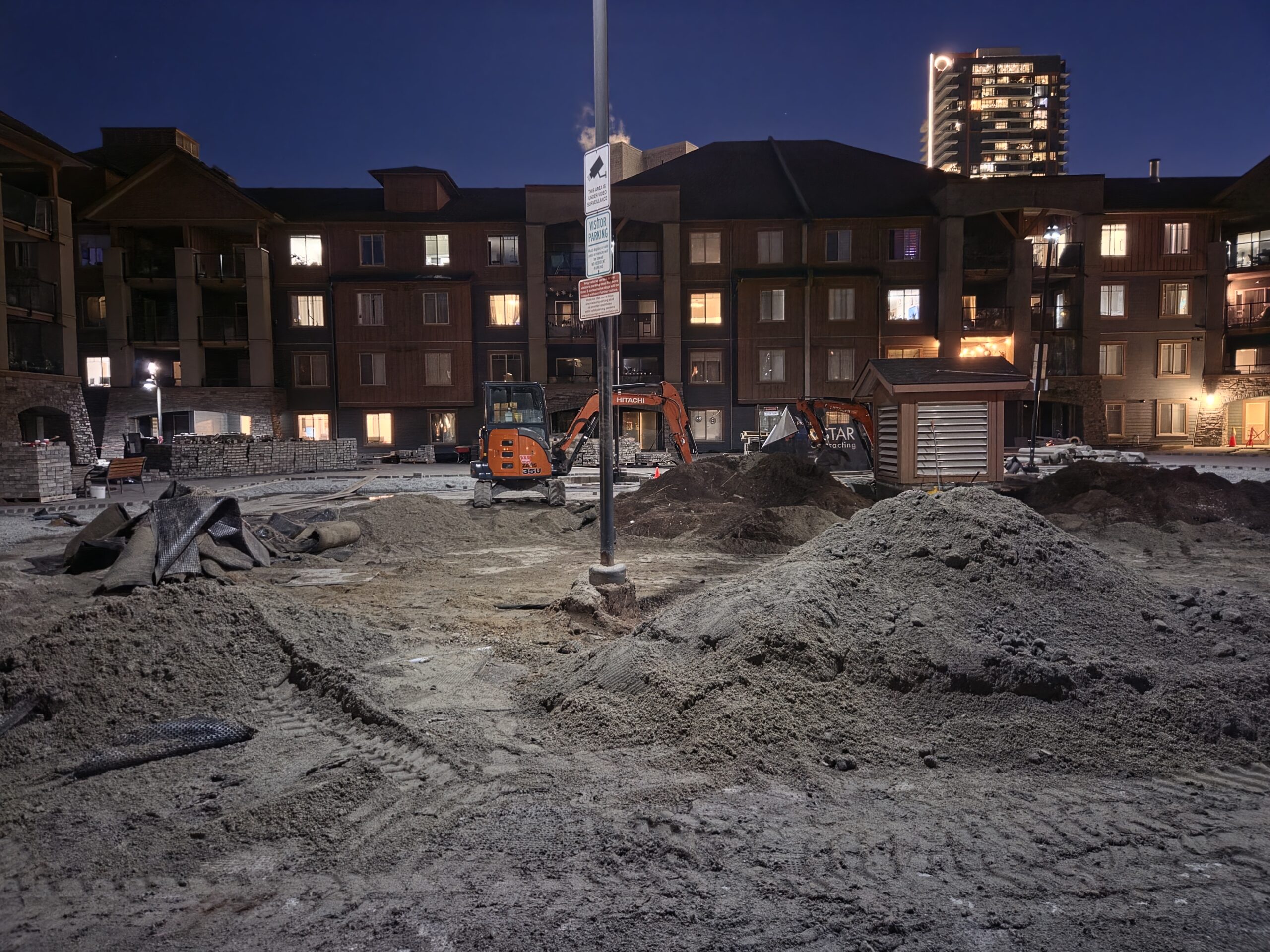

Phase 2 membrane project, Day 105–November 26, 2026

Phase 2 Membrane Replacement Project

Project Mobilization Date: July 20, 2026
Work Start Date: May 4, 2026 (for emergency repairs)
Expected completion: December 2026
Primary contractor: Prostar
Engineering design: Strata Engineering

Weather: 12°C, heavy rain with late clearing, clouds
Workers onsite: At least 5

Work done today:

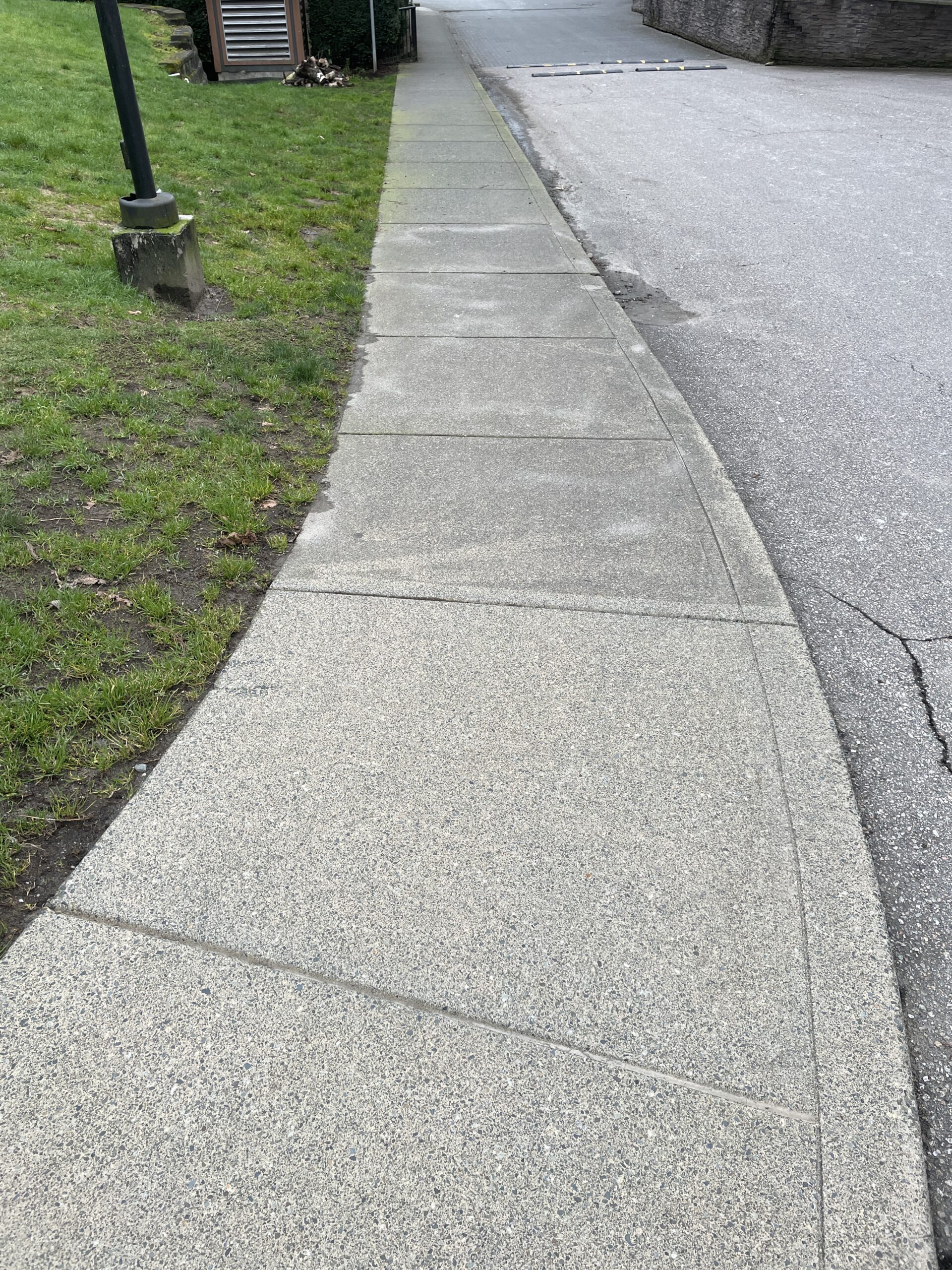

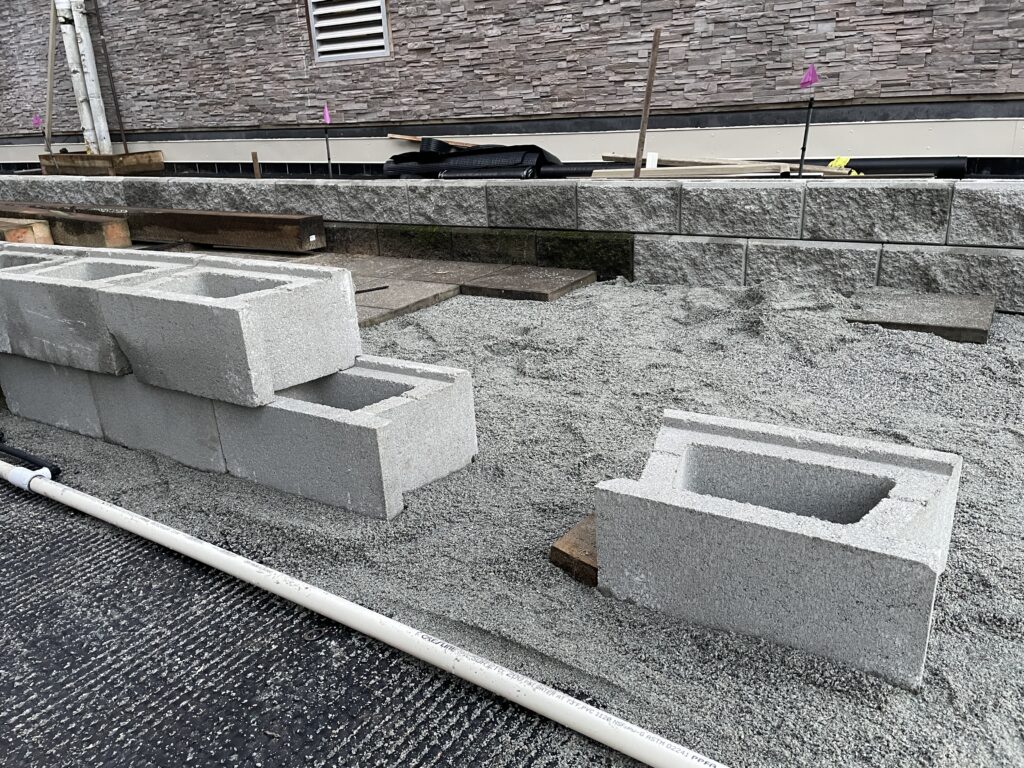

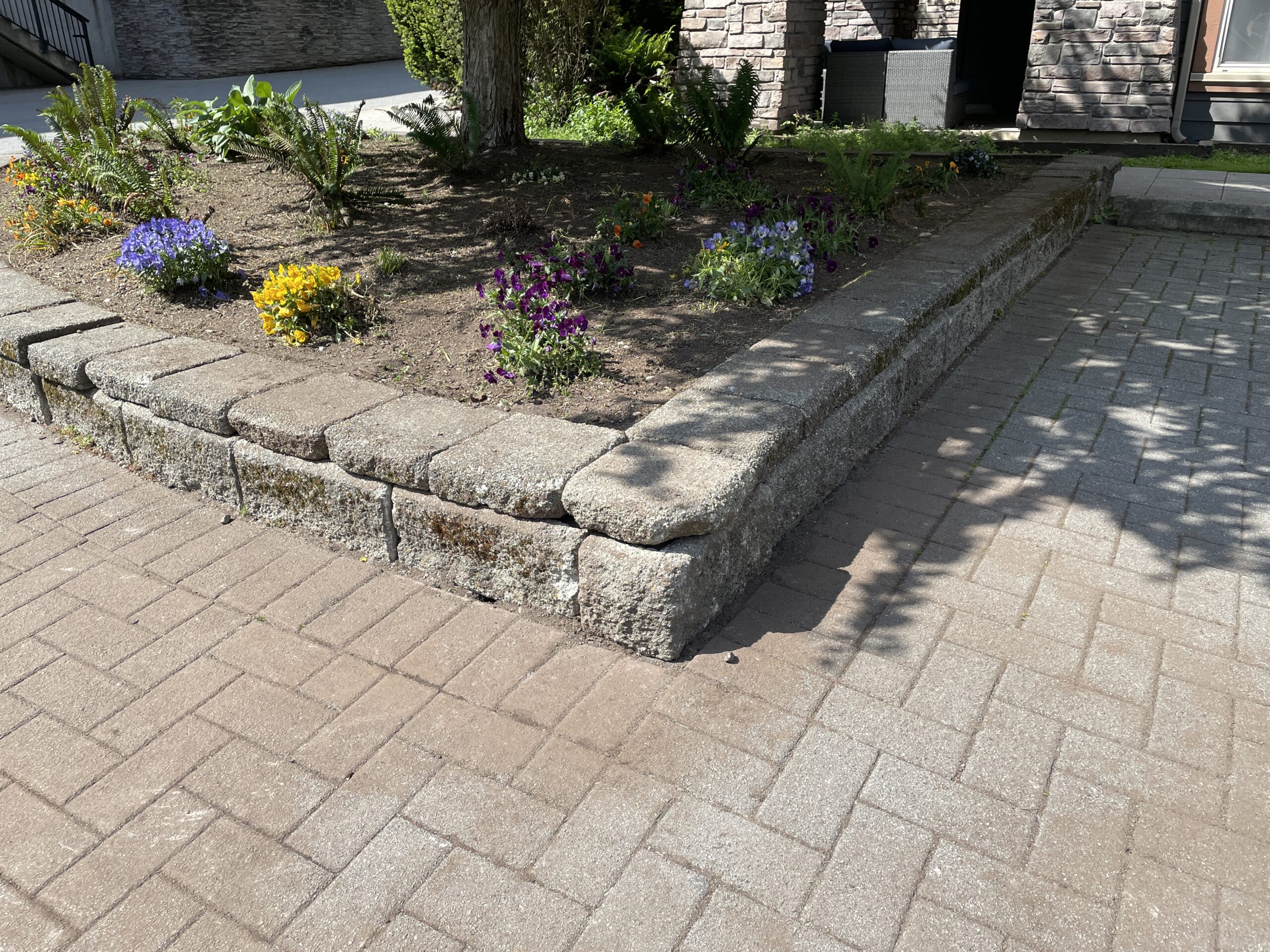

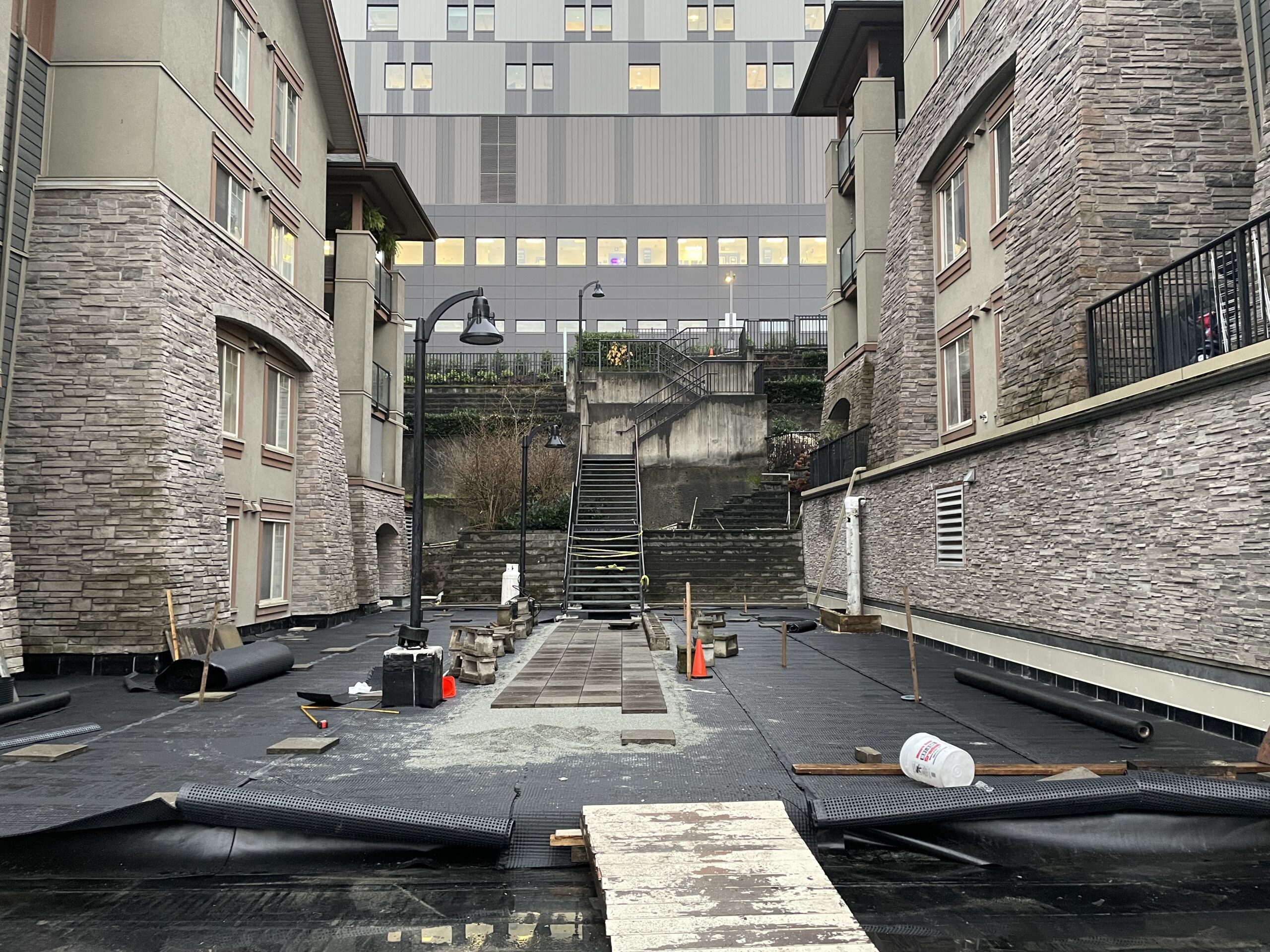

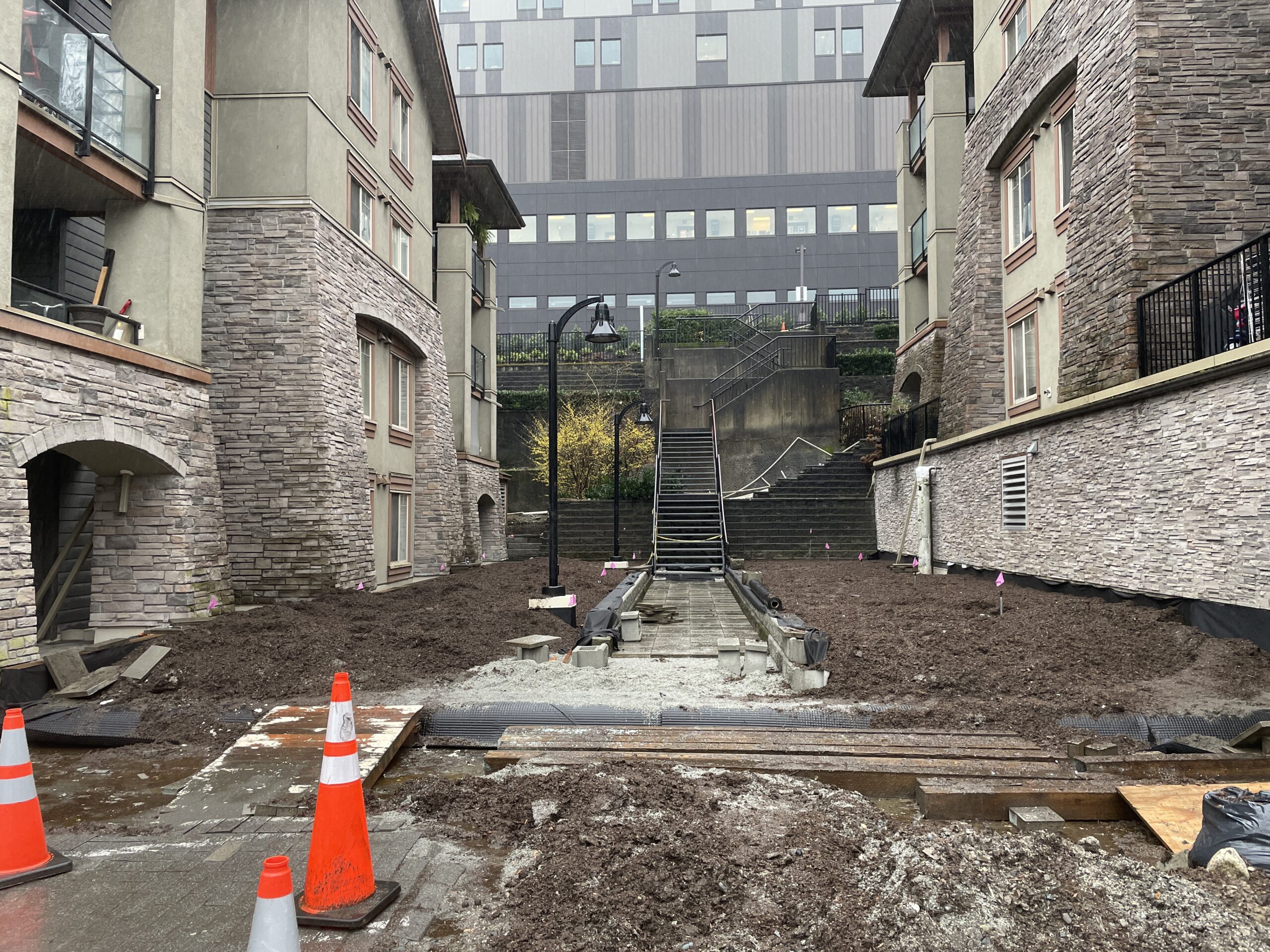

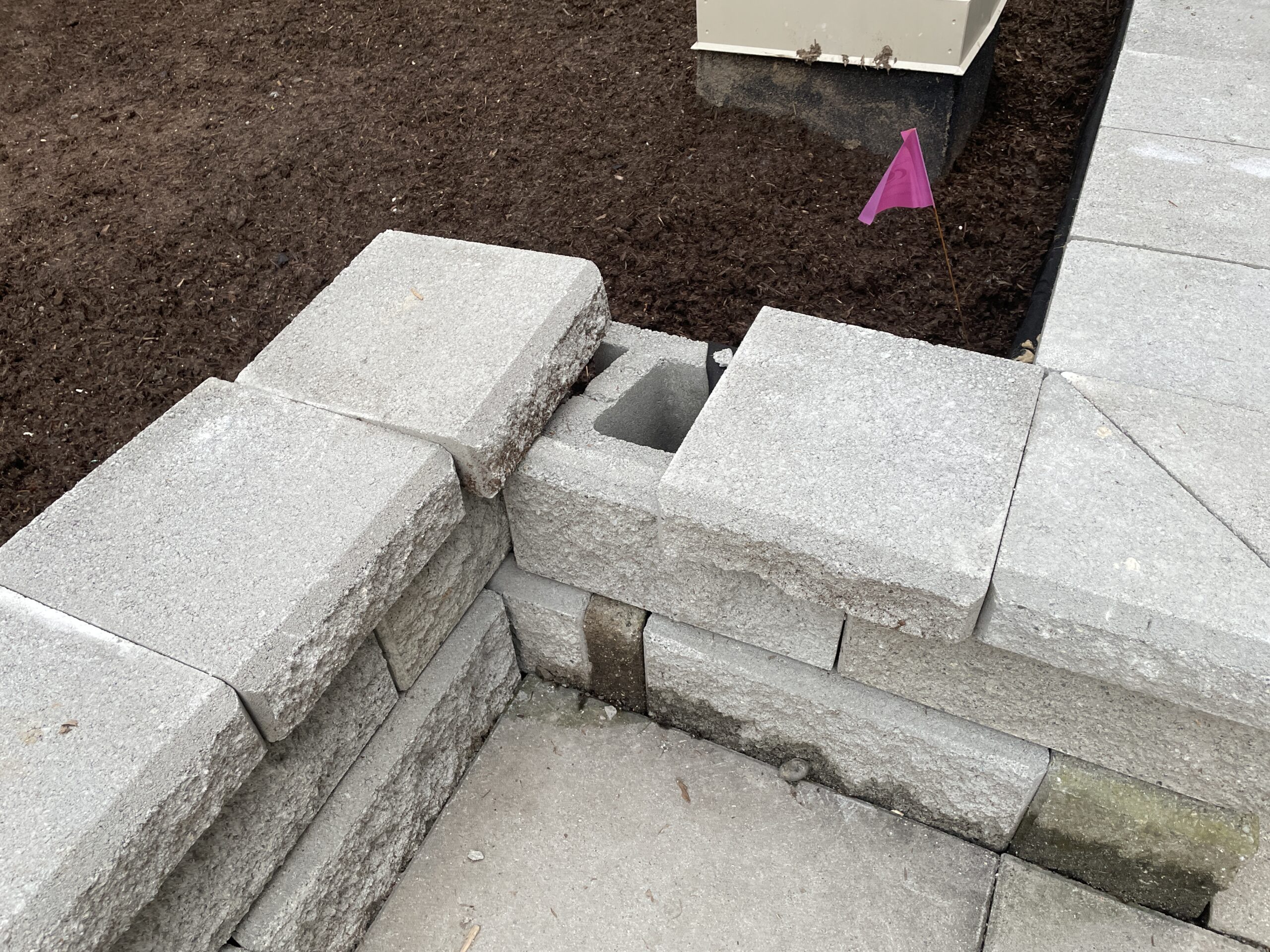

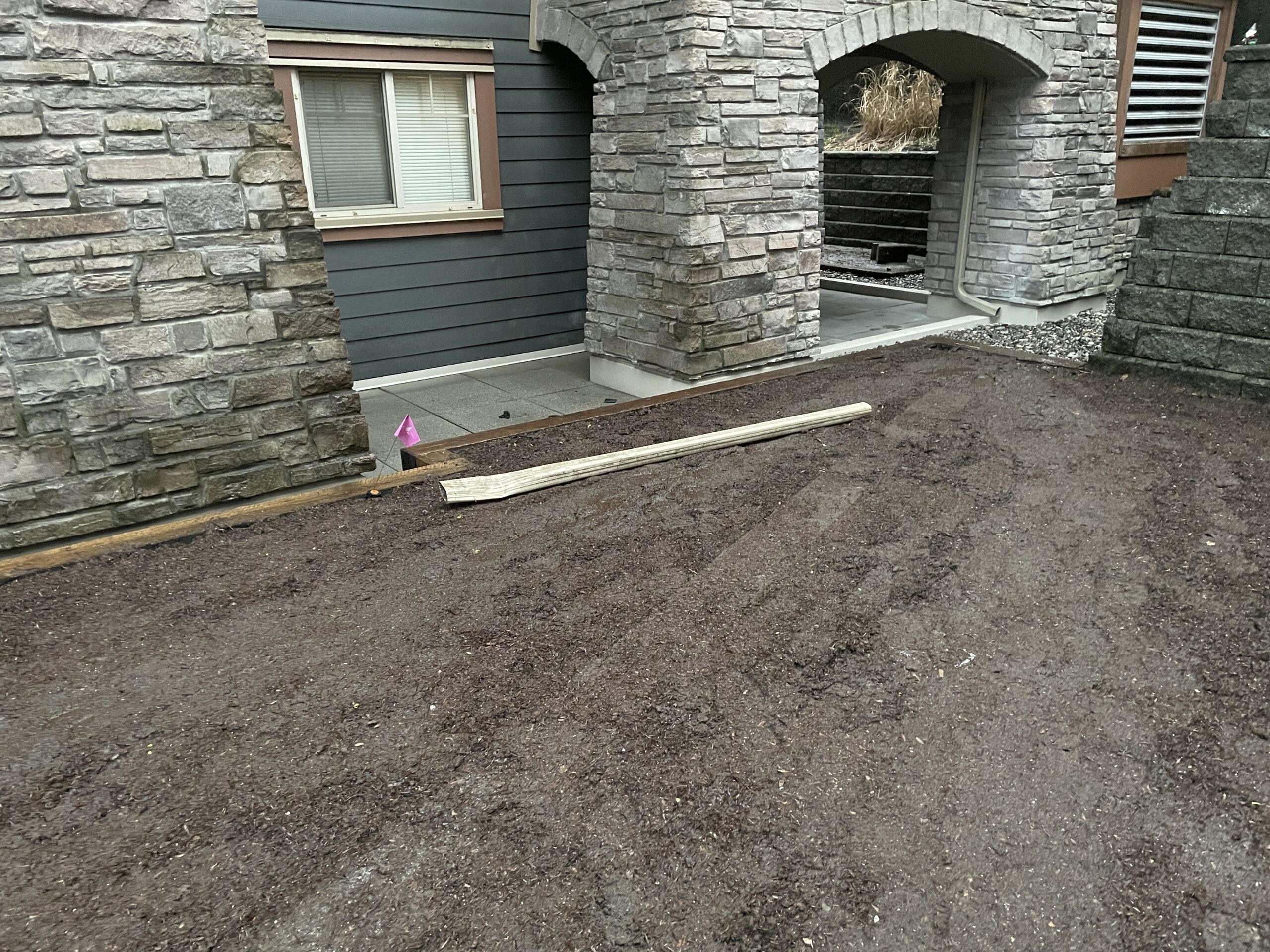

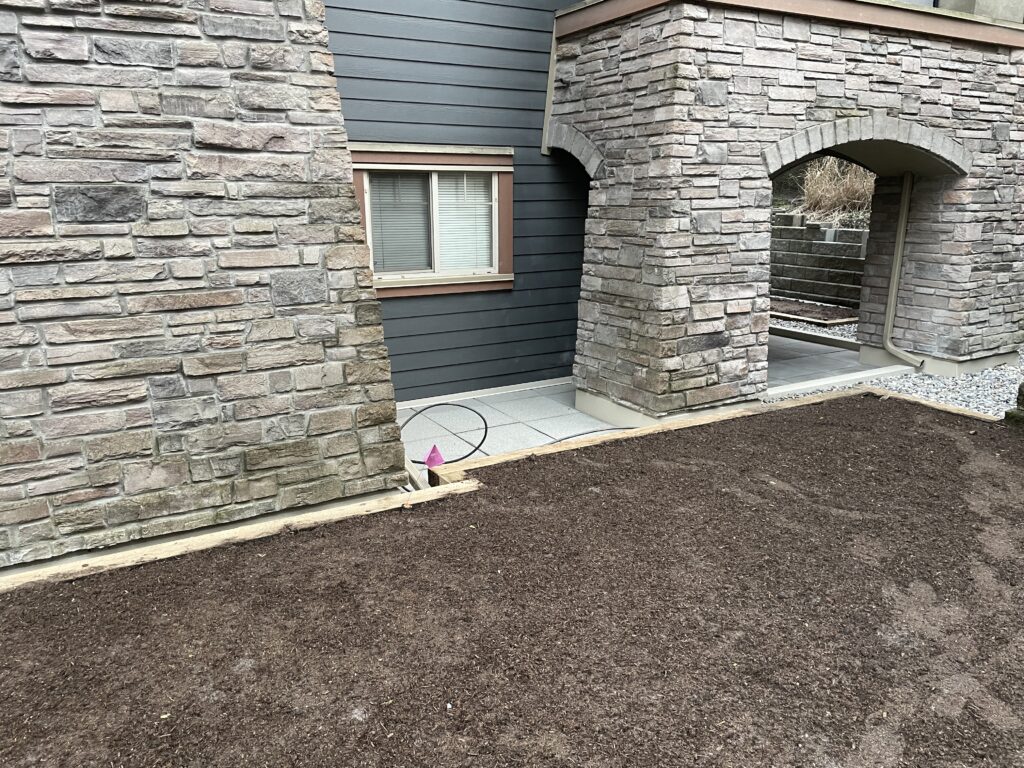

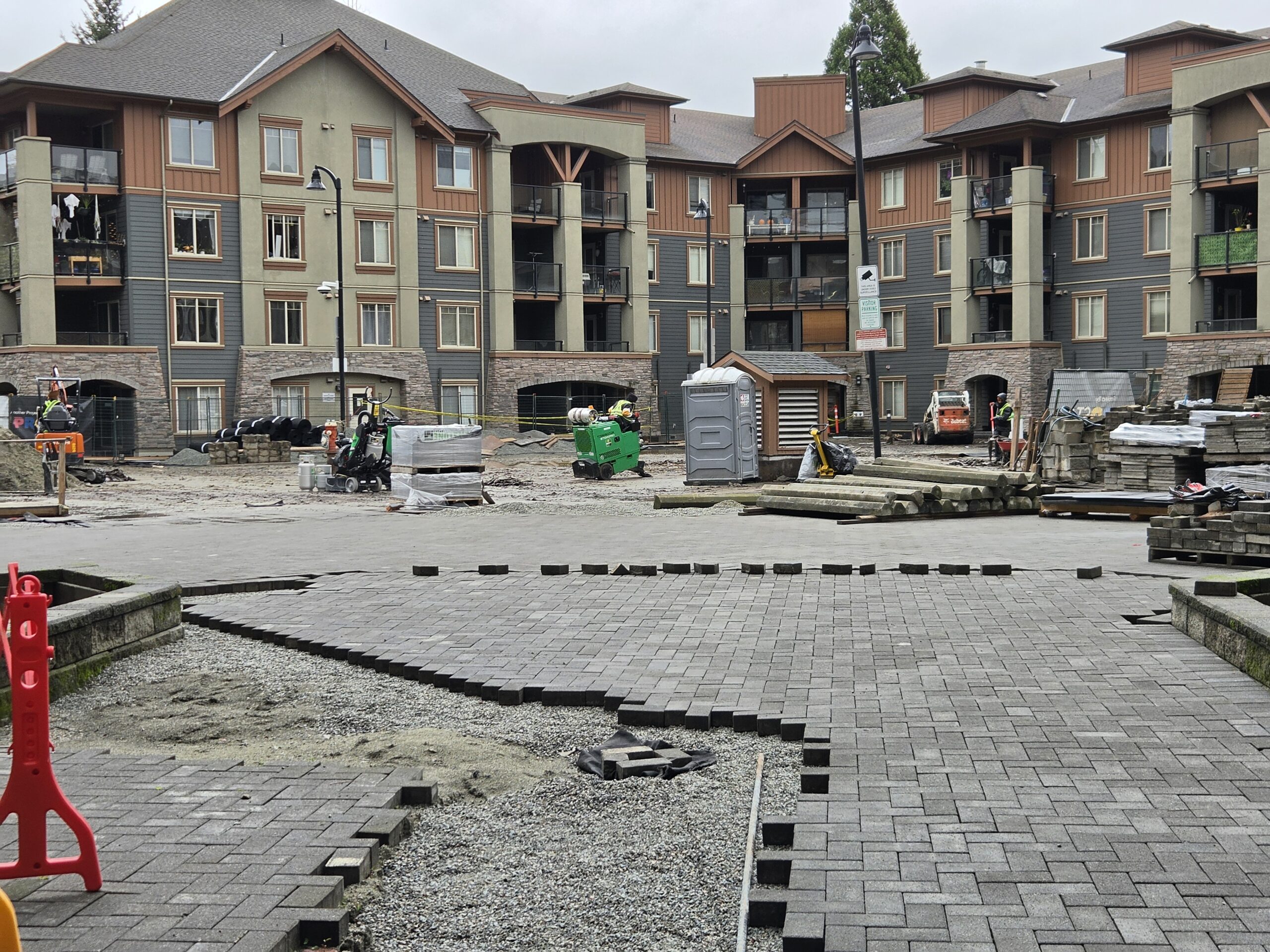

  • Concrete brick placed for the garden area adjacent to the Building 240 entrance and alongside initial part of the sidewalk on the north side of the Visitor Parking

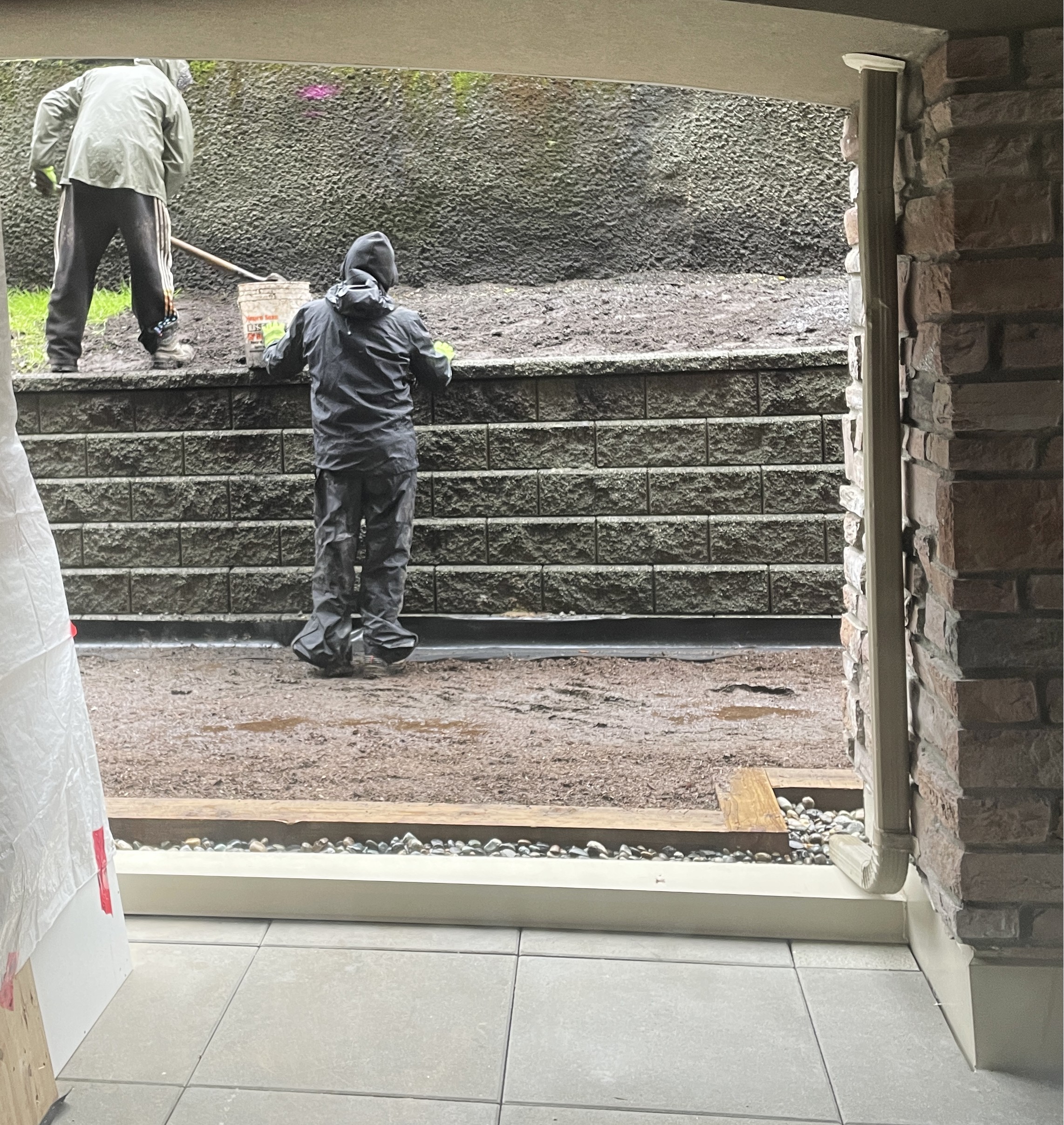

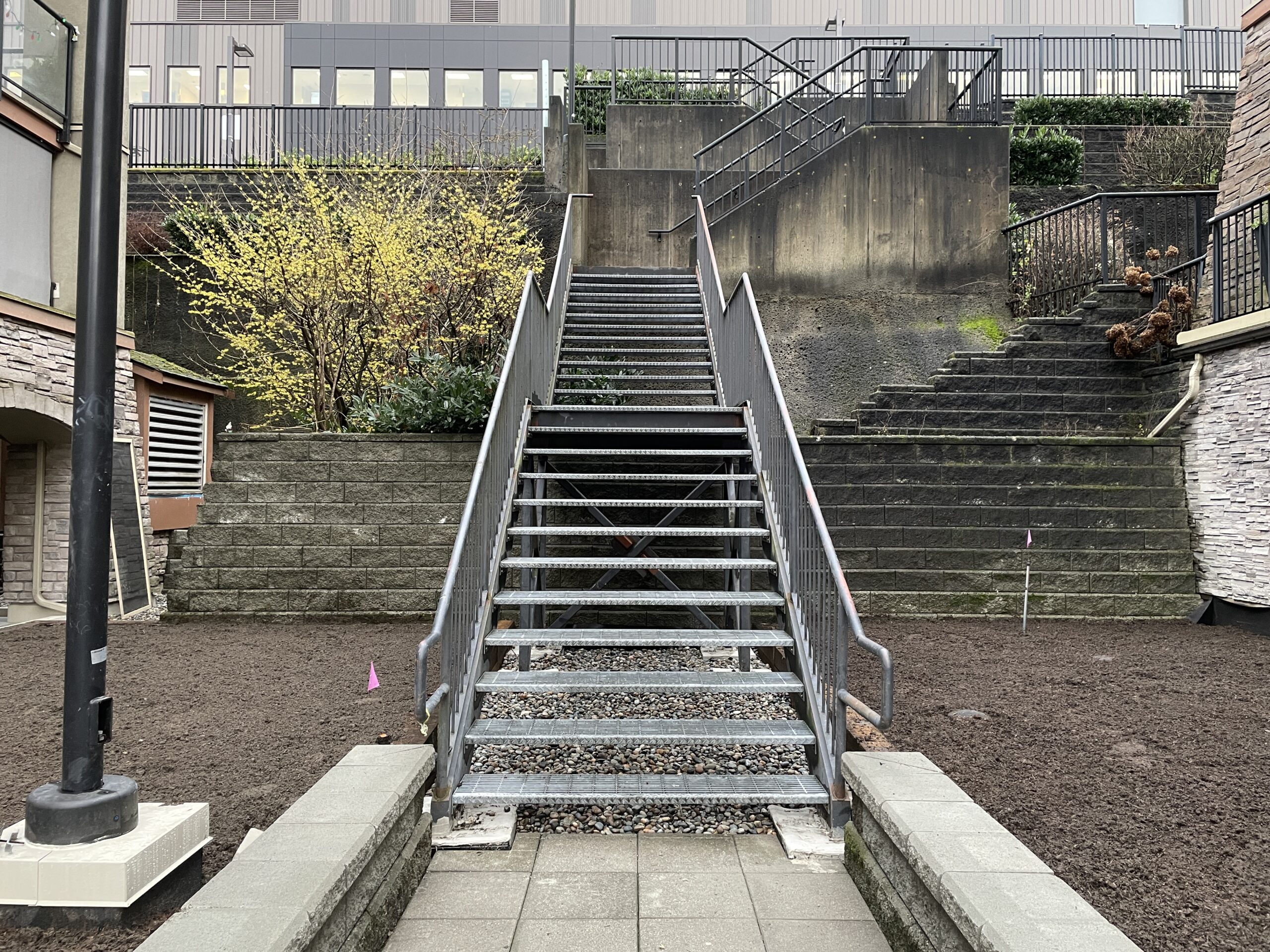

  • Additional compacting of gravel and placing of pavers around the 240 entrance

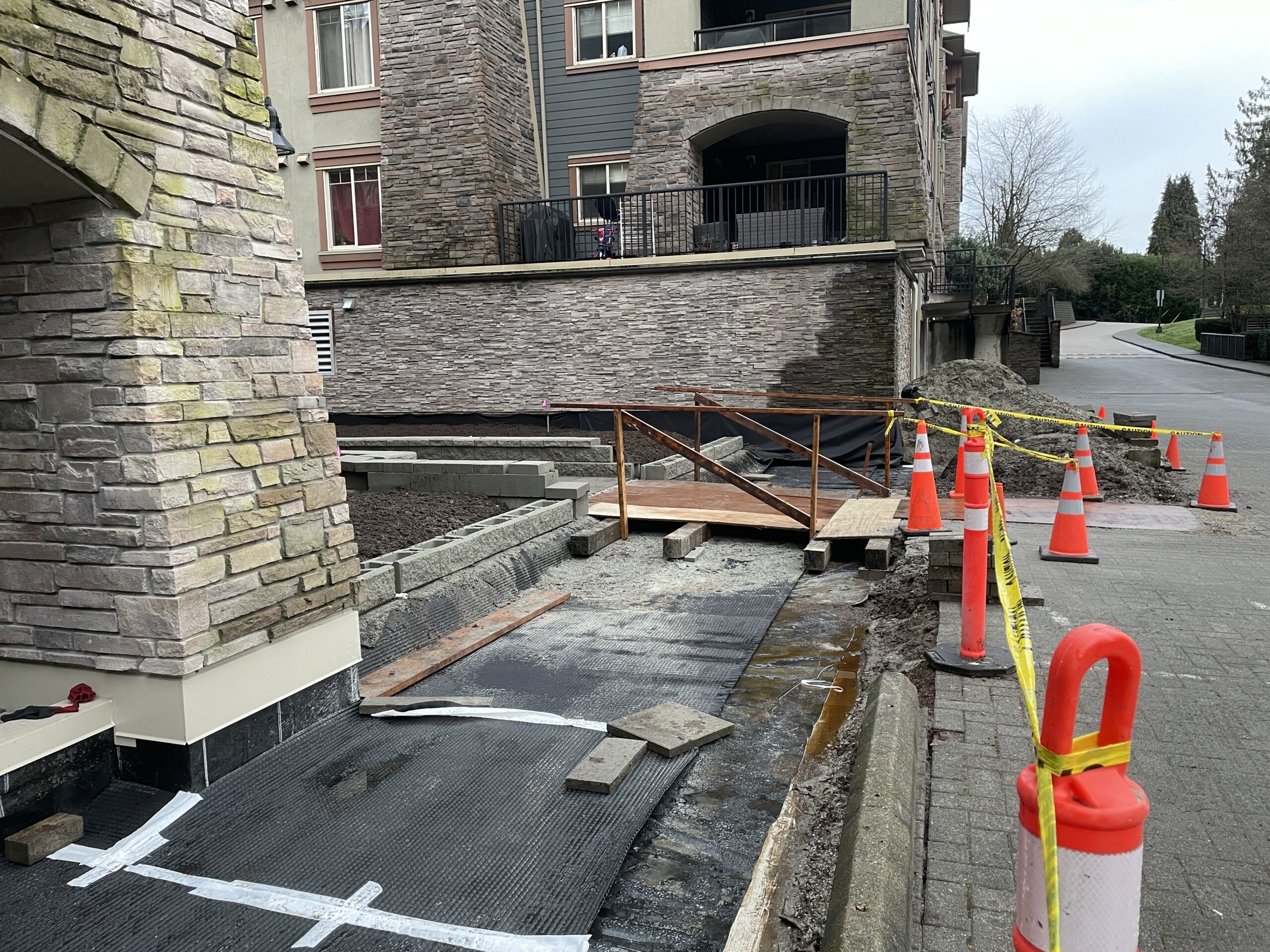

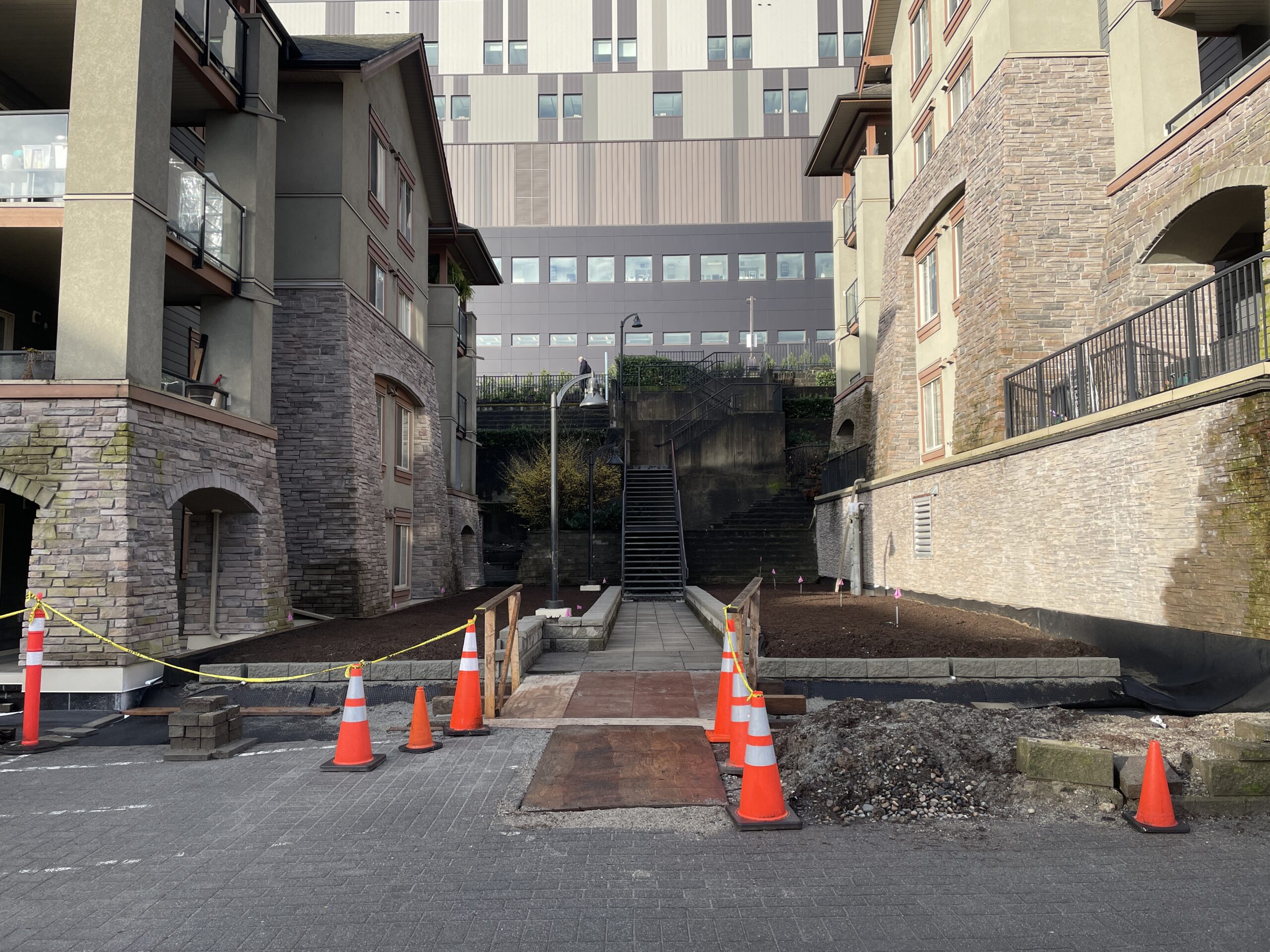

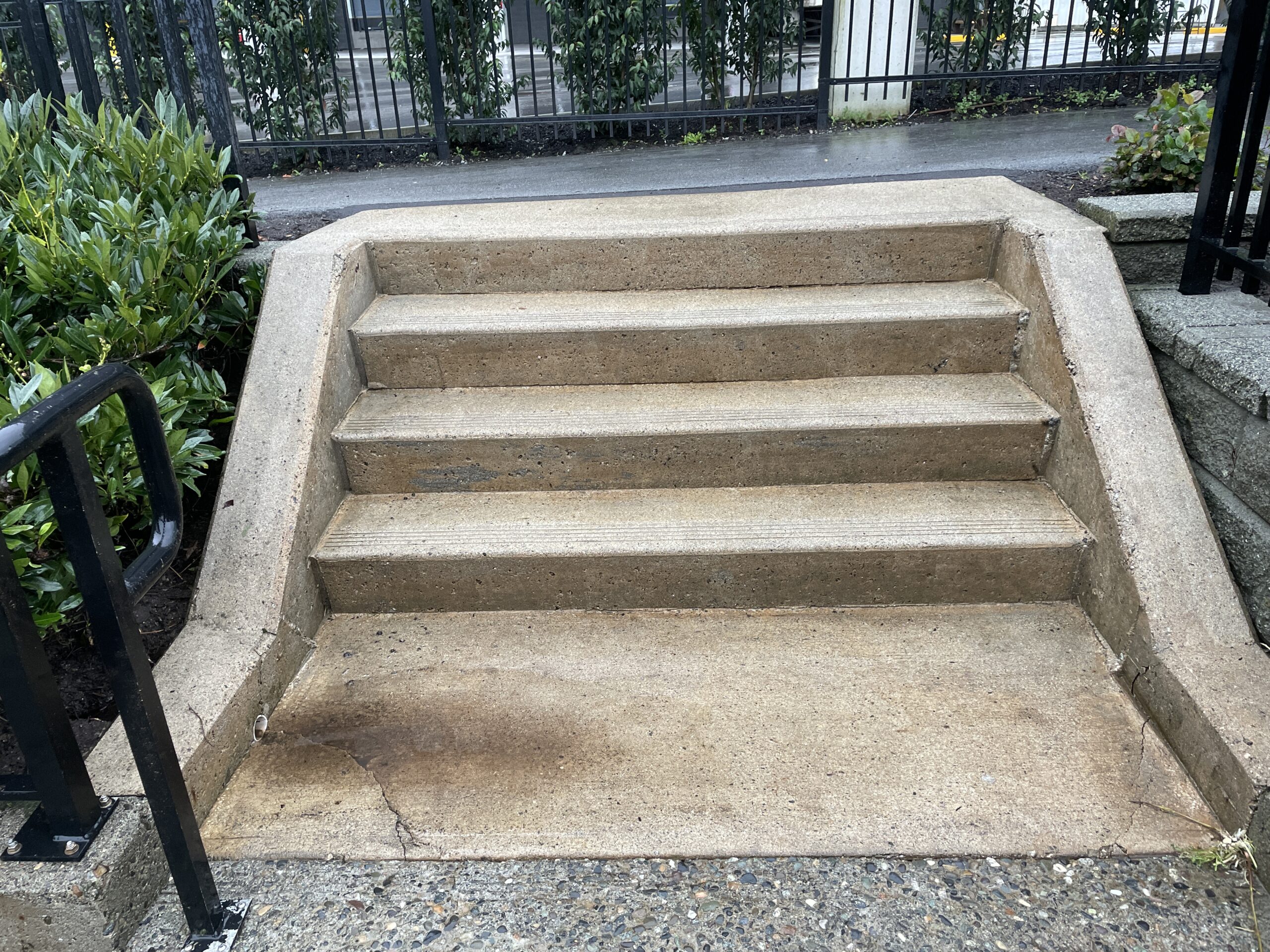

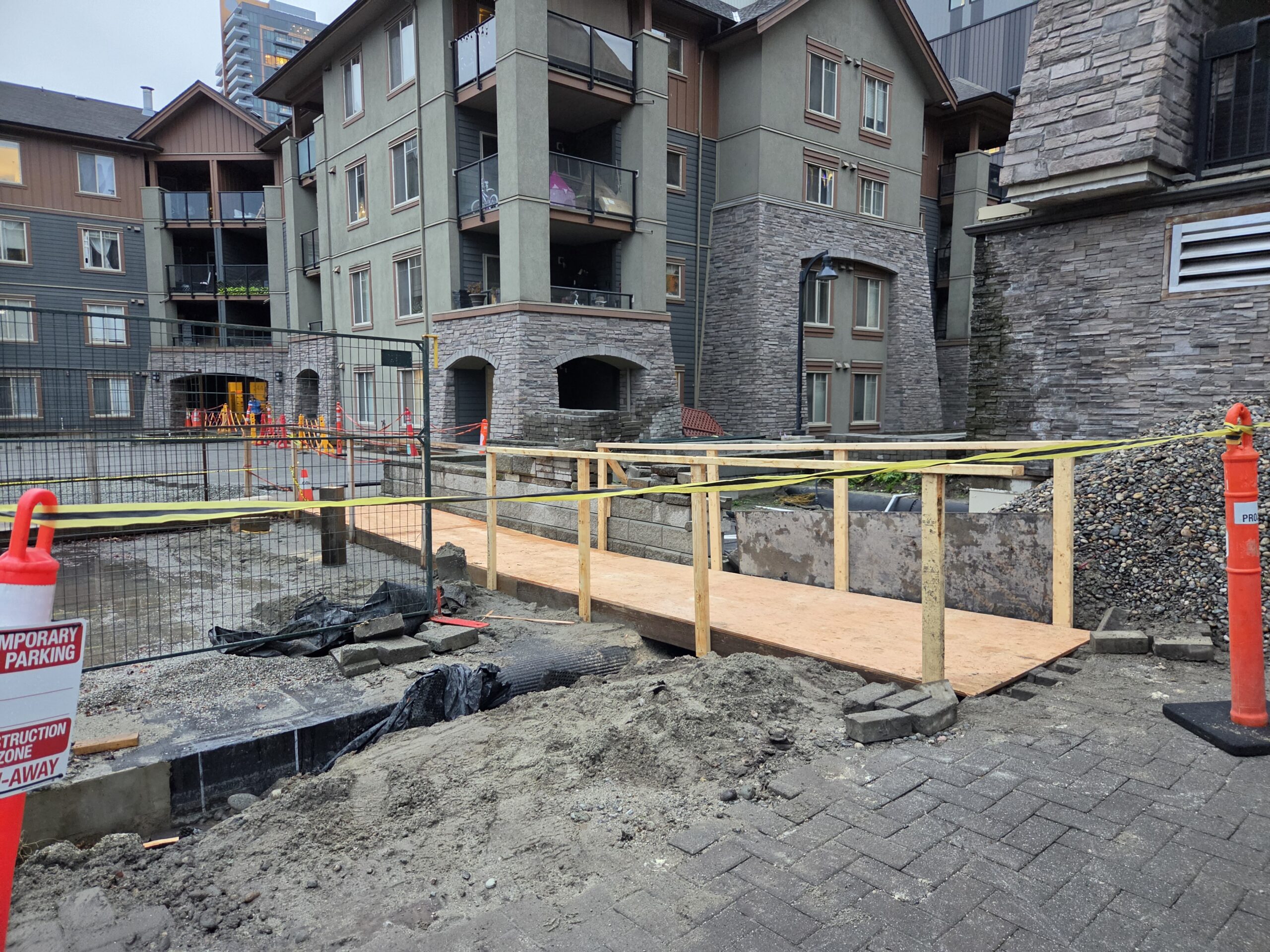

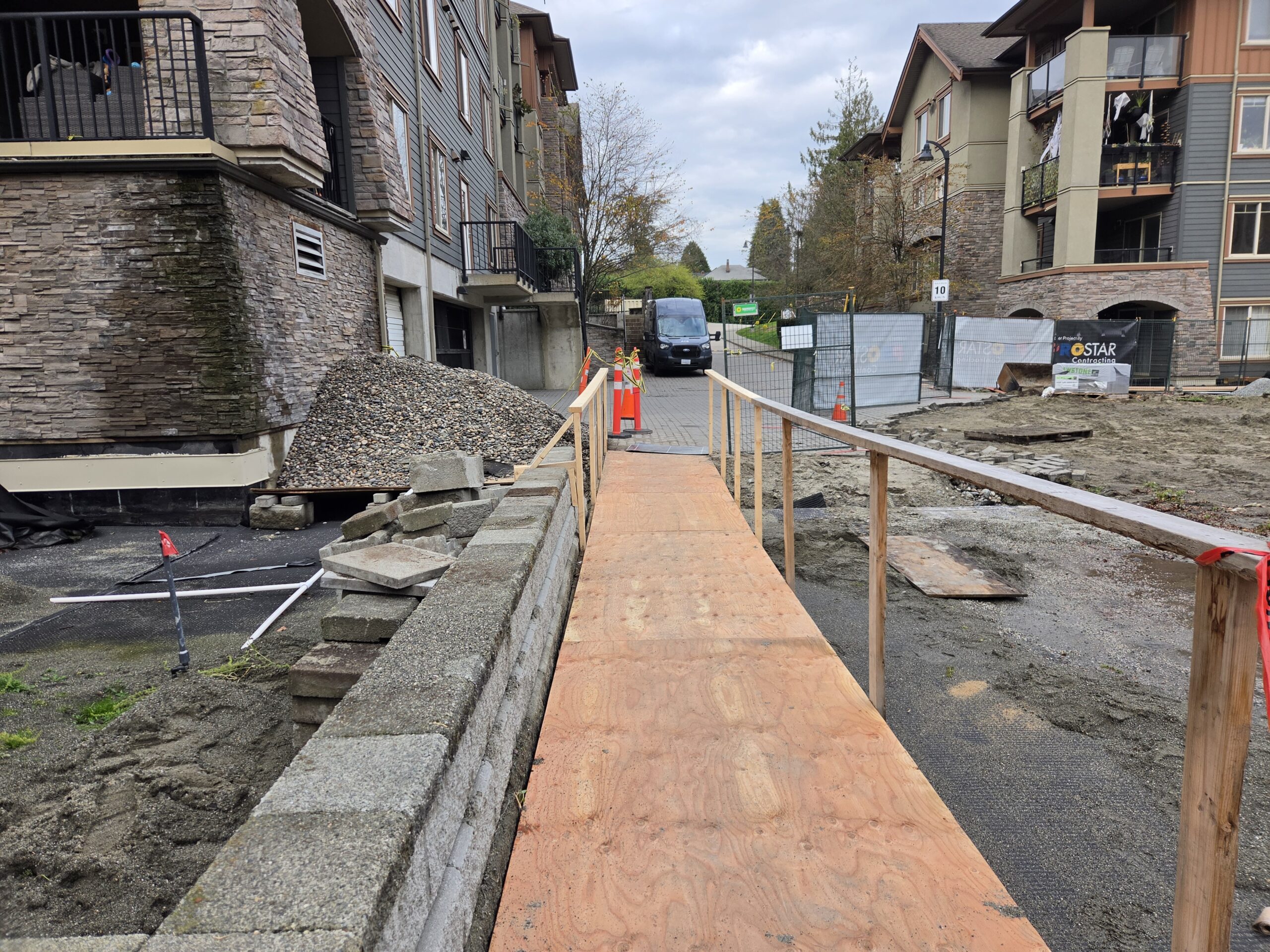

  • Building 240 entrance re-opened, with temporary path to driveway

November 2026 Council Membrane Report

Here is the Copperstone Council November 2026 Membrane Report. The end is near! (in a good way)

Also, this very website is mentioned! I try to keep all information I post here accurate and anything that is my opinion is labelled as such. If you ever see errors or have any feedback, feel free to write: admin@copperstonecommunity.org or copperstonecommunity@fastmail.com

Phase 2 membrane project, Day 104–November 25, 2026

Phase 2 Membrane Replacement Project

Project Mobilization Date: July 20, 2026
Work Start Date: May 4, 2026 (for emergency repairs)
Expected completion: December 2026
Primary contractor: Prostar
Engineering design: Strata Engineering

Weather: 12°C, rain with occasional breaks
Workers onsite: At least 4

Work done today:

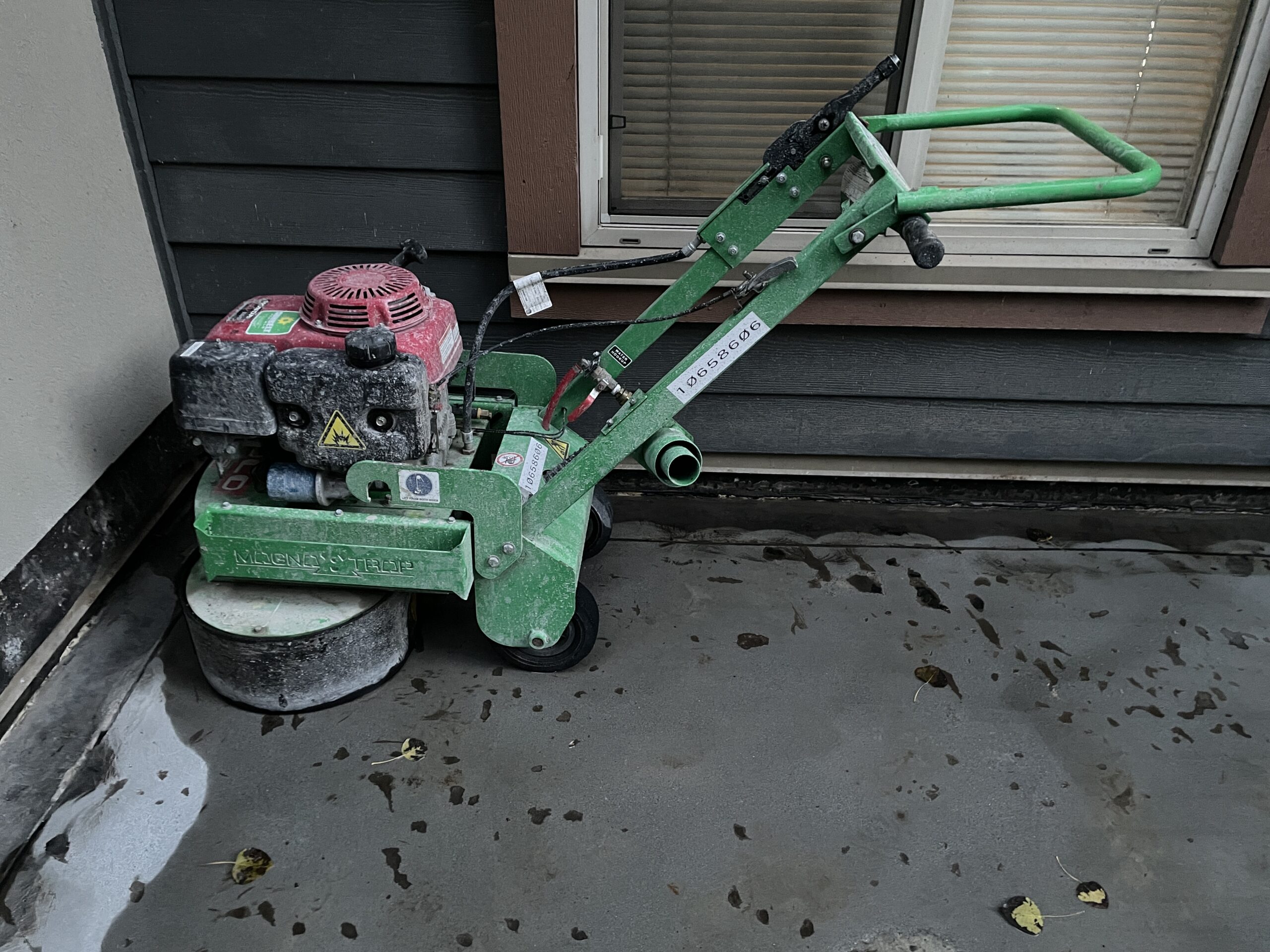

  • Gravel compacted in front of Building 240 entrance
  • Pavers partly reinstated in front of Building 240 entrance

Phase 2 membrane project, Day 103–November 24, 2026

Phase 2 Membrane Replacement Project

Project Mobilization Date: July 20, 2026
Work Start Date: May 4, 2026 (for emergency repairs)
Expected completion: December 2026
Primary contractor: Prostar
Engineering design: Strata Engineering

Weather: 11°C, cloudy, intermittent showers
Workers onsite: At least 4

Work done today:

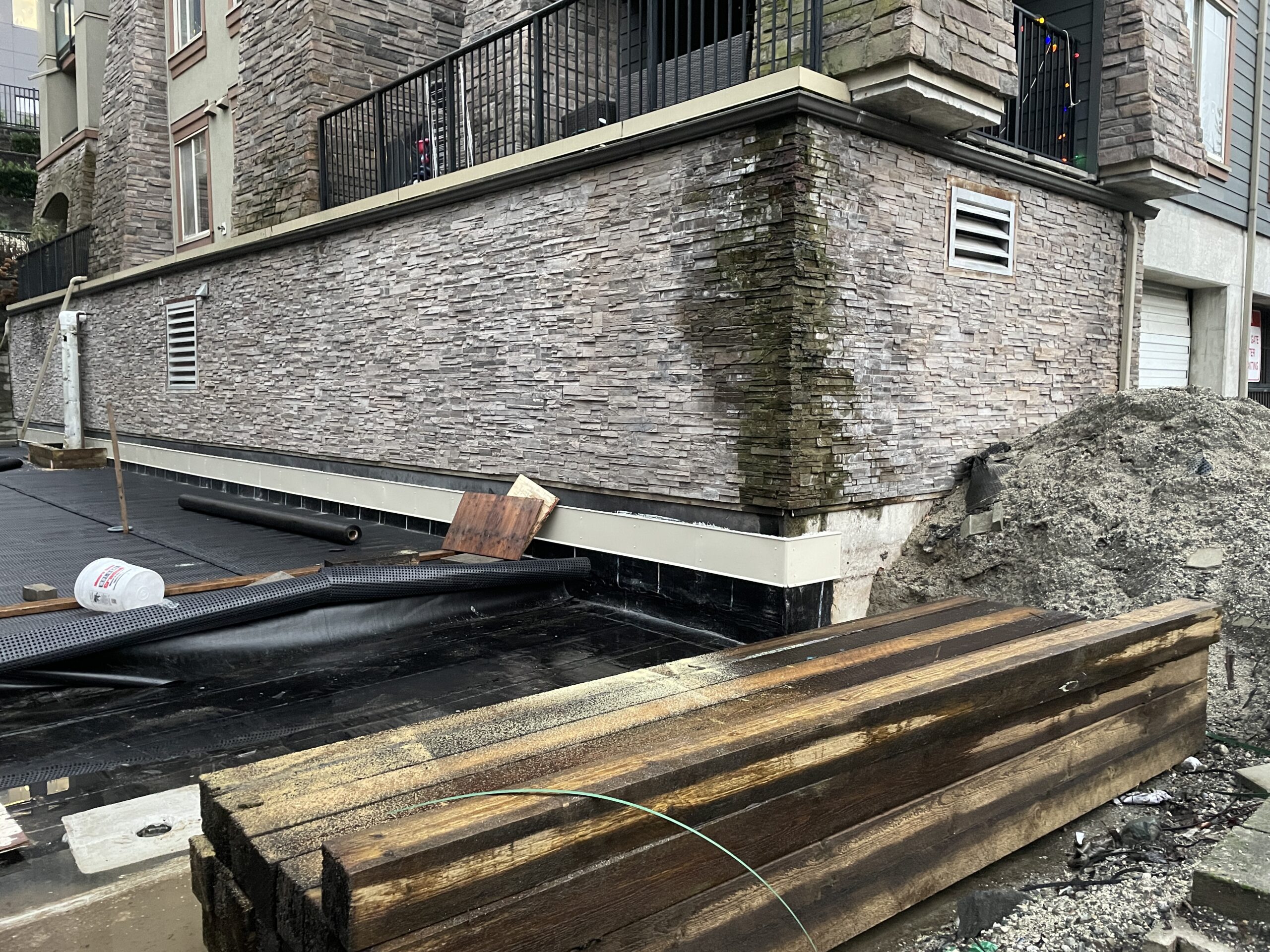

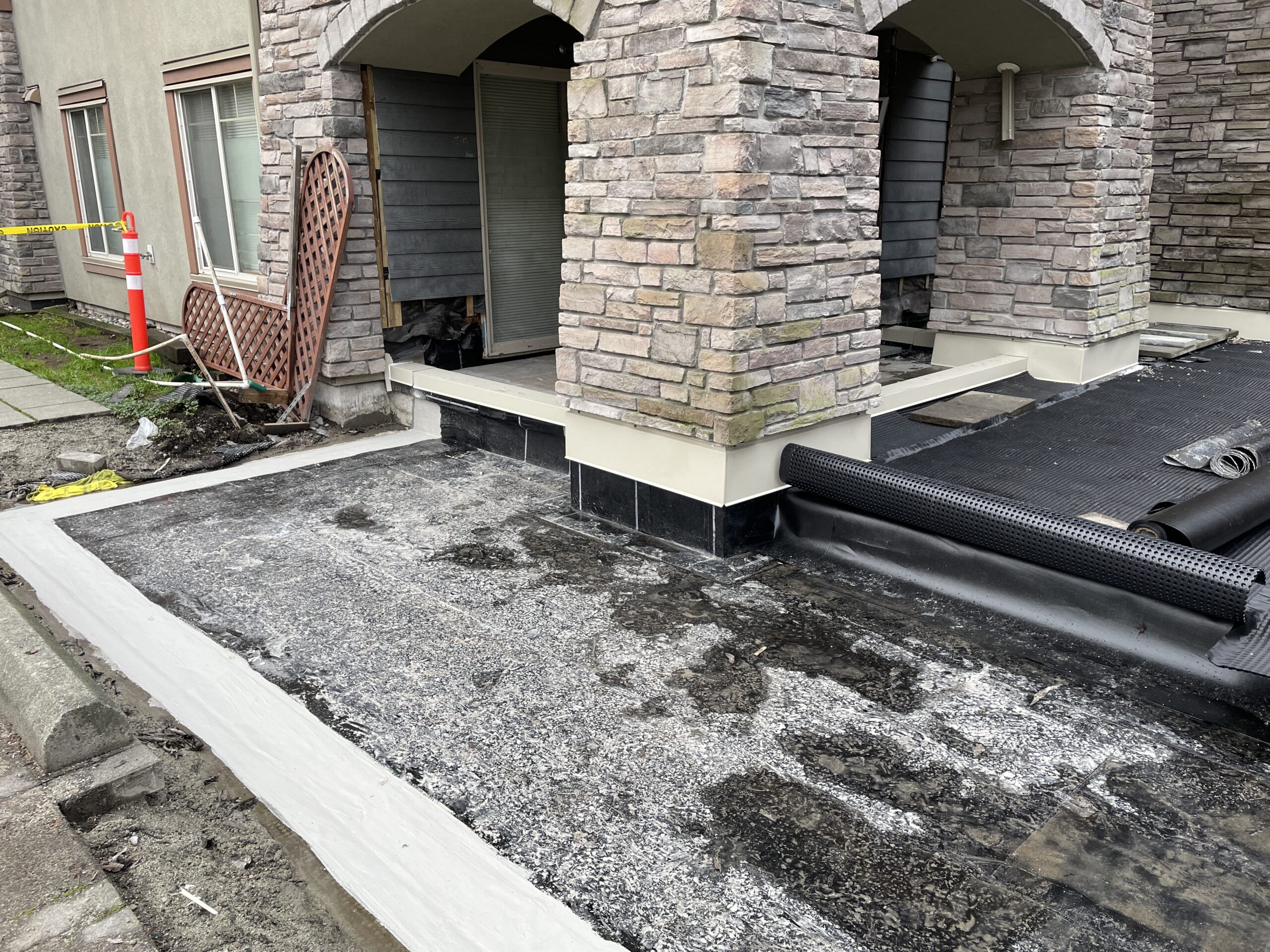

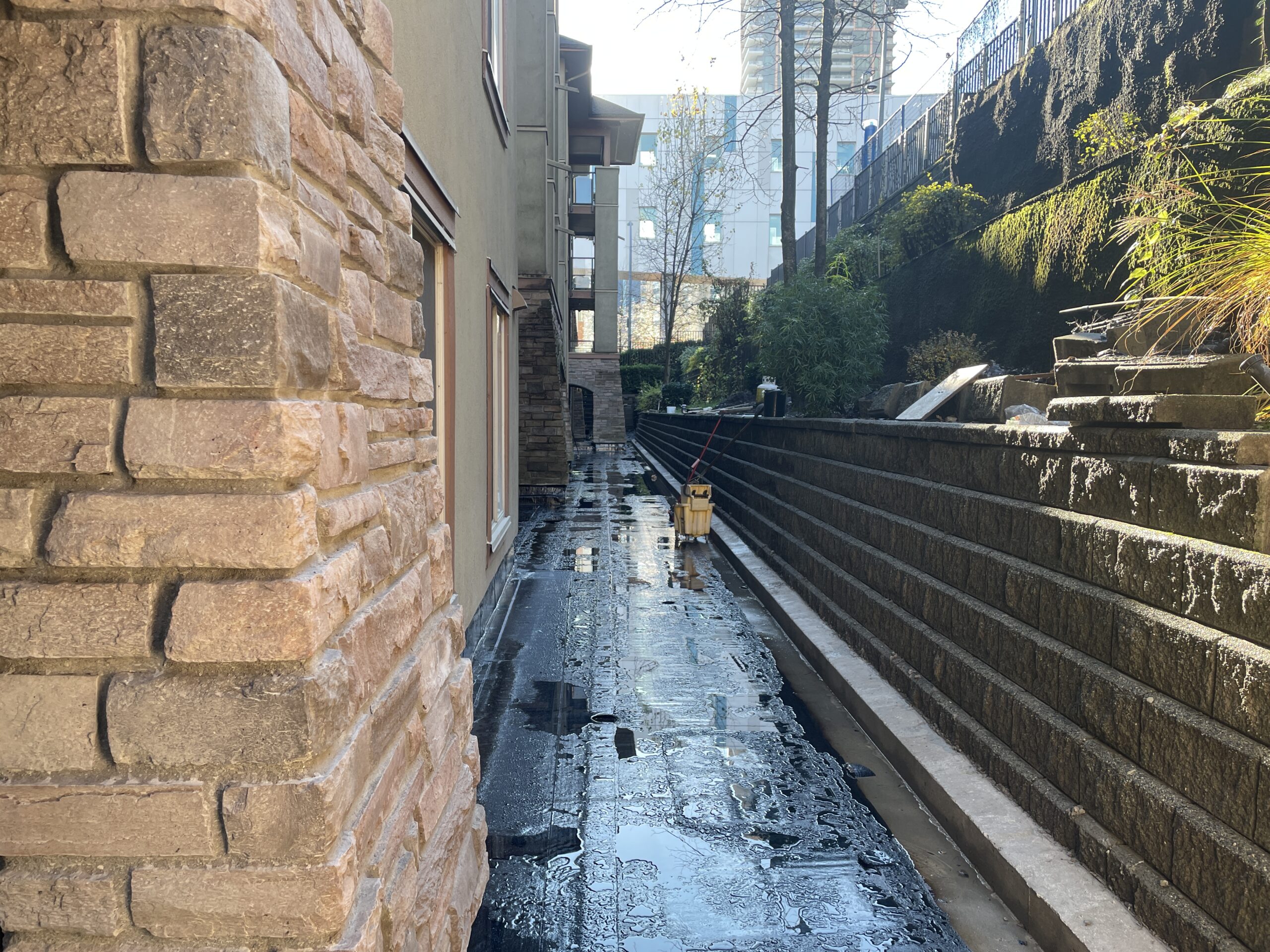

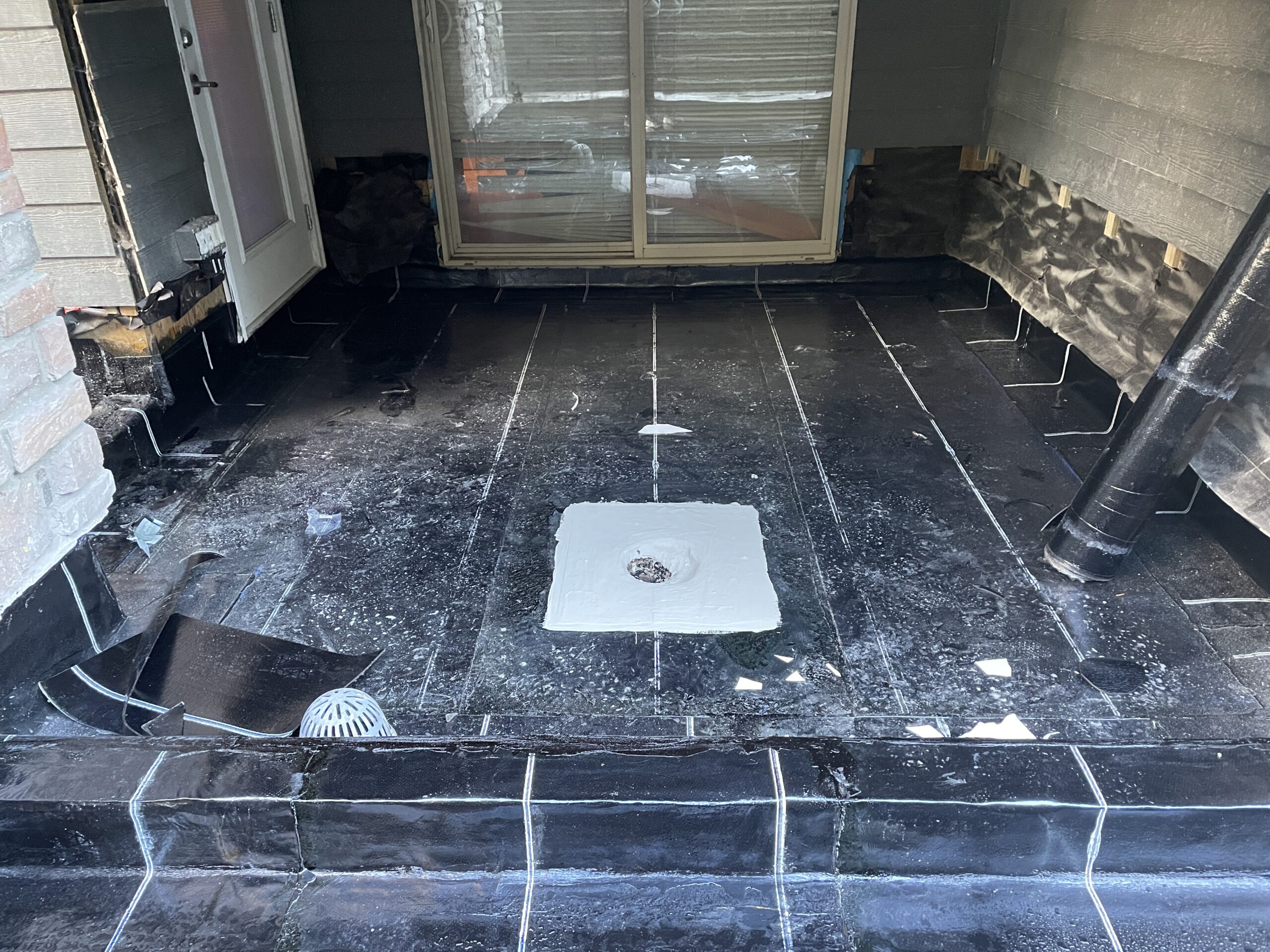

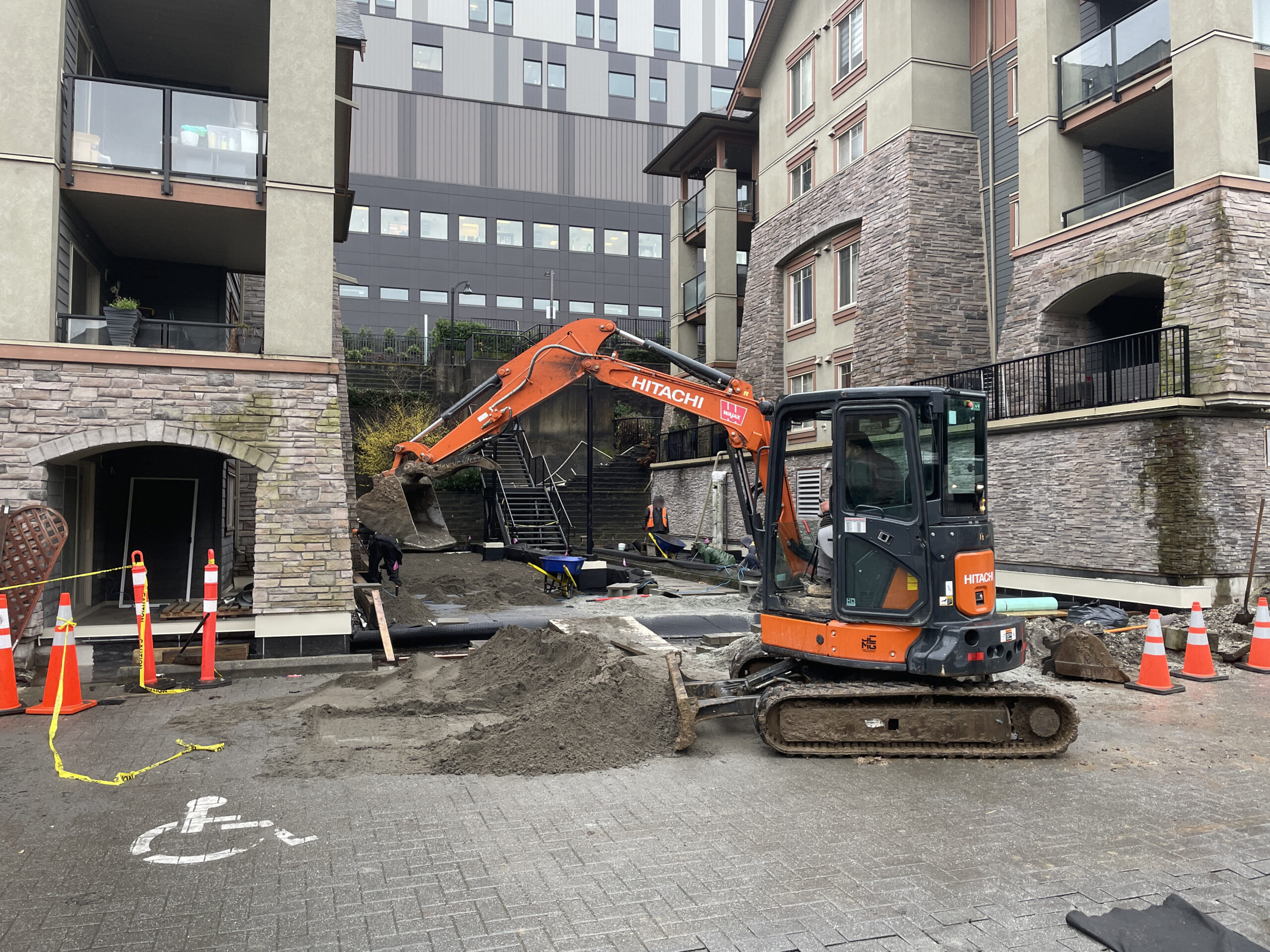

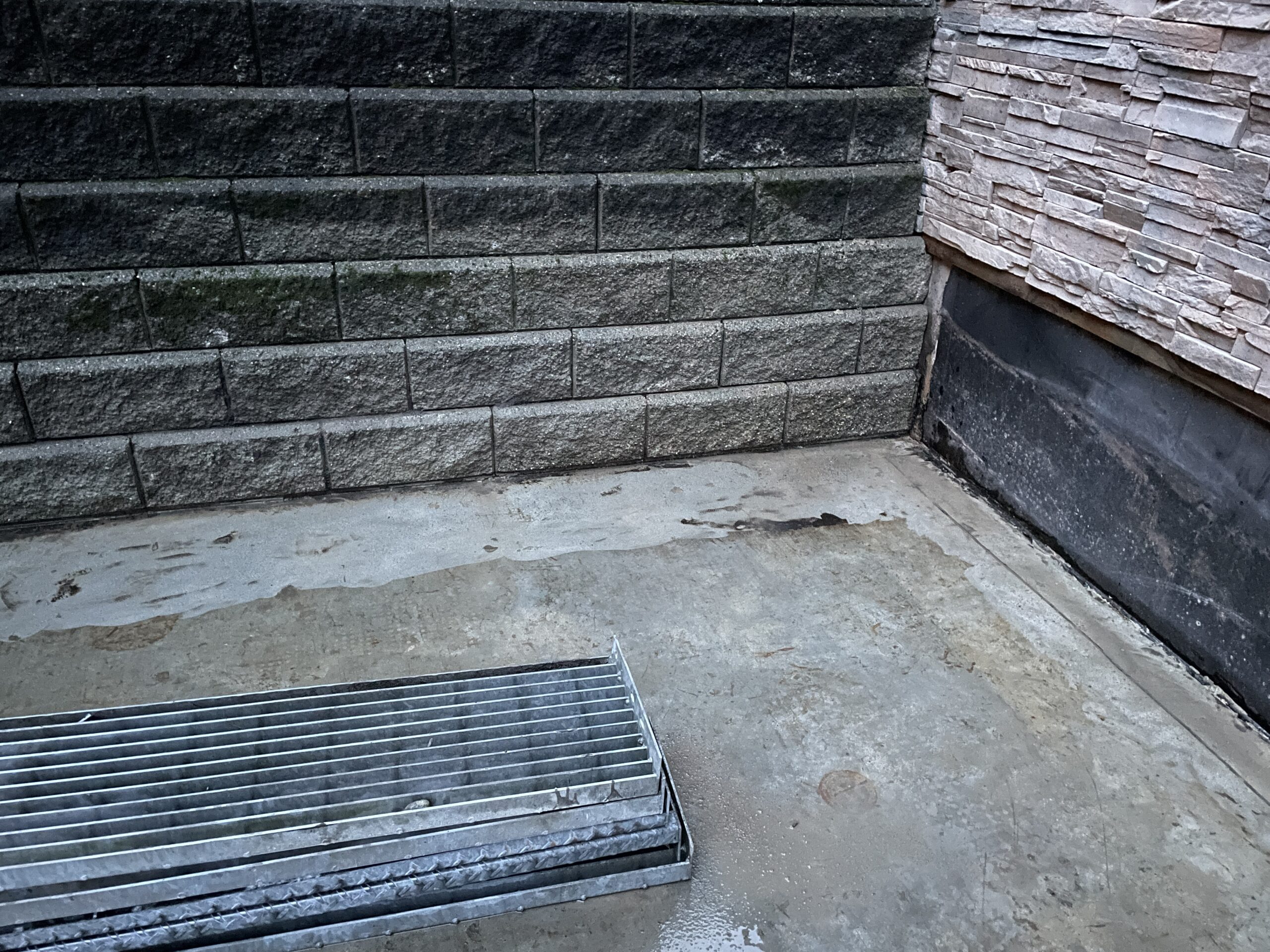

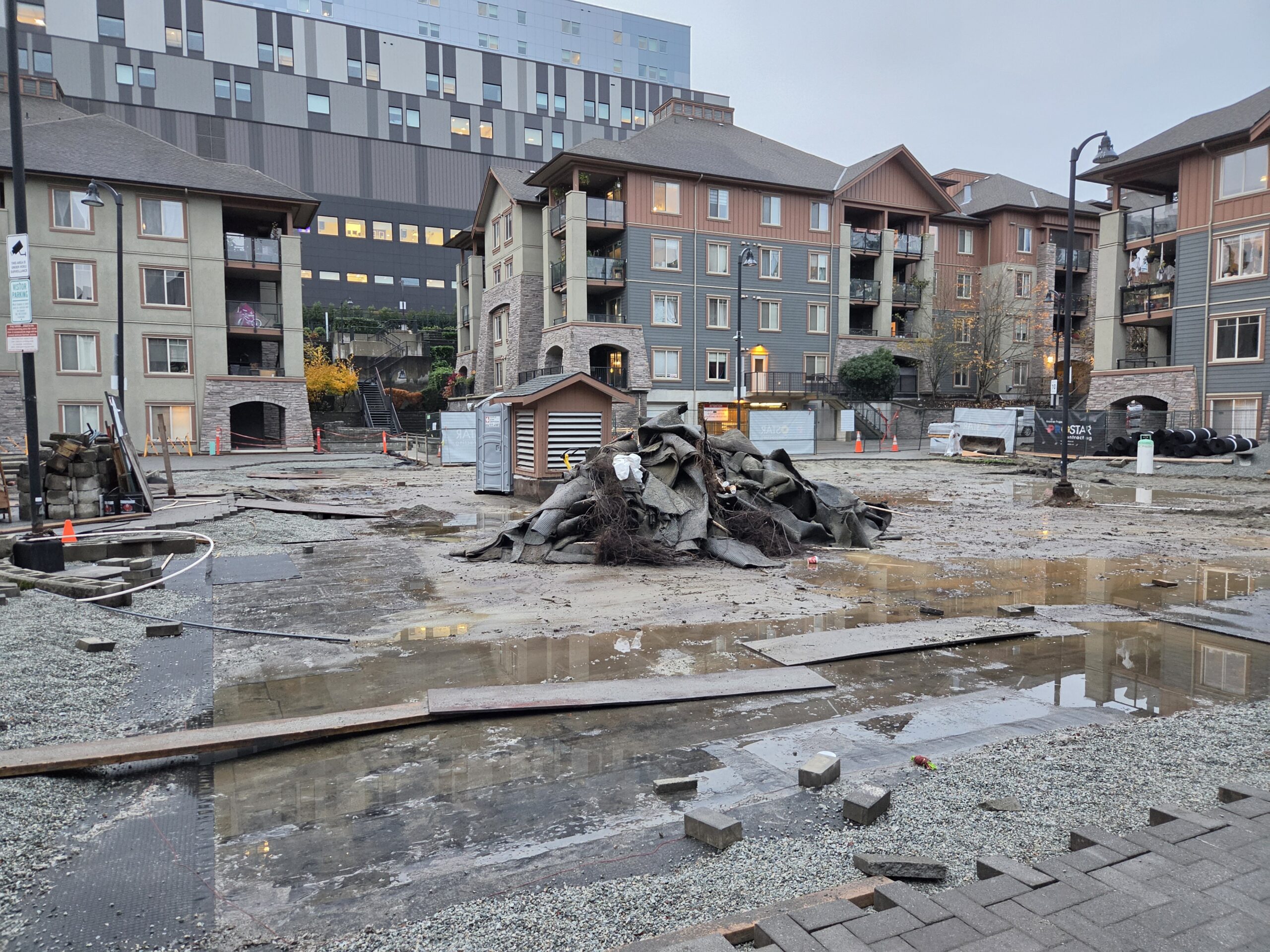

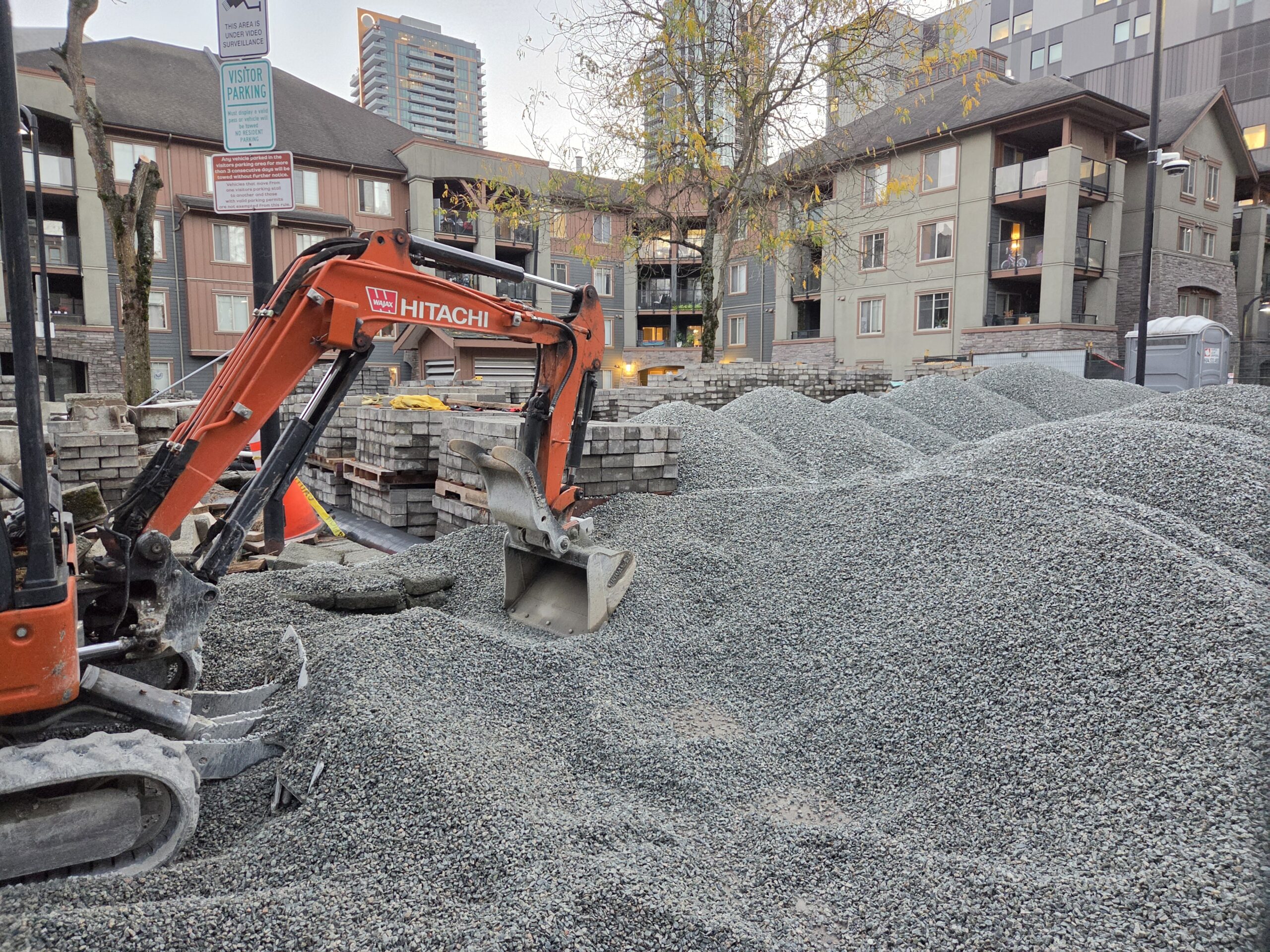

  • Gravel/substrate poured at the entrance to Building 240 and nearby areas
  • Other work may have been done, but I could not observe any changes

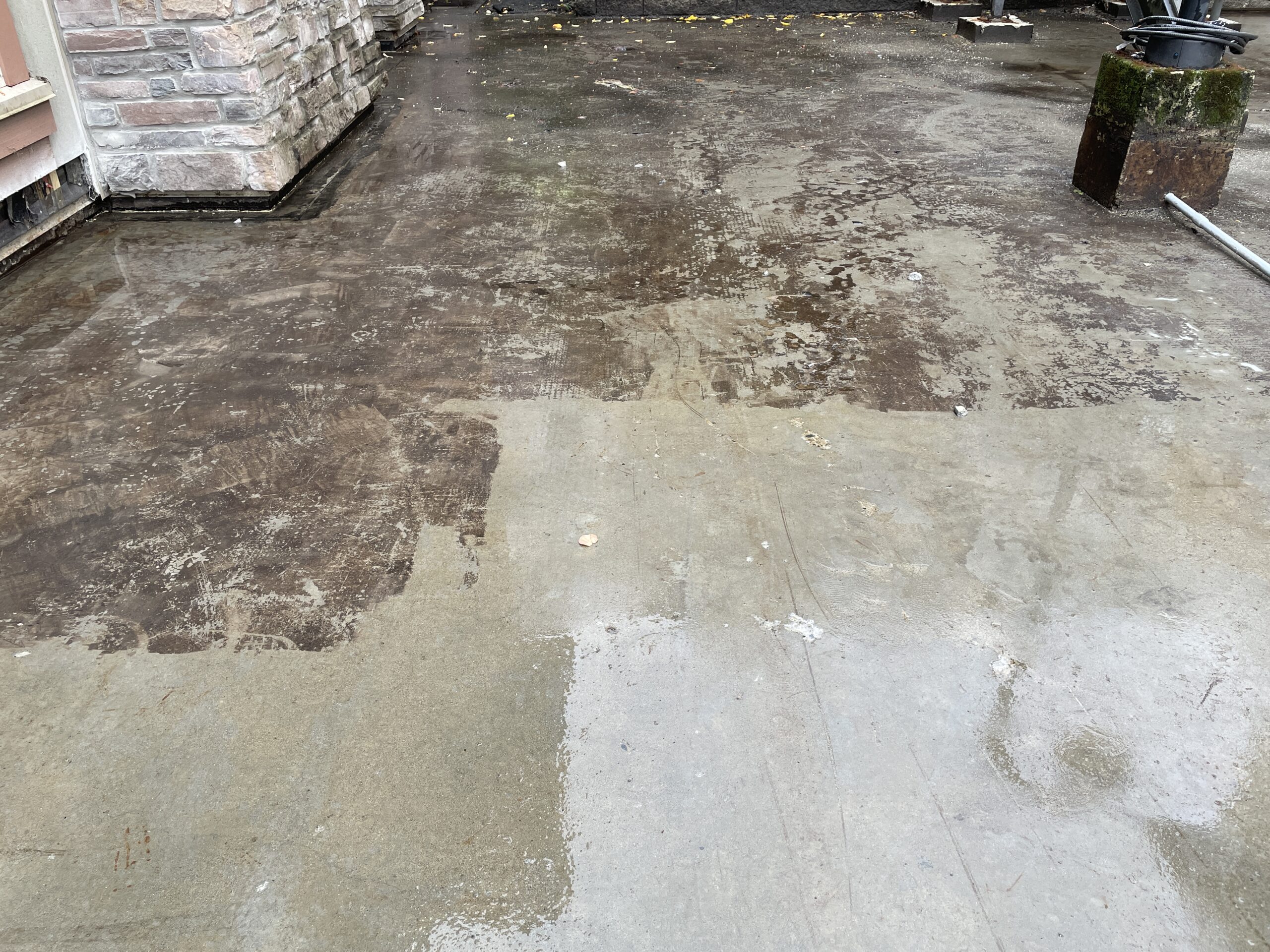

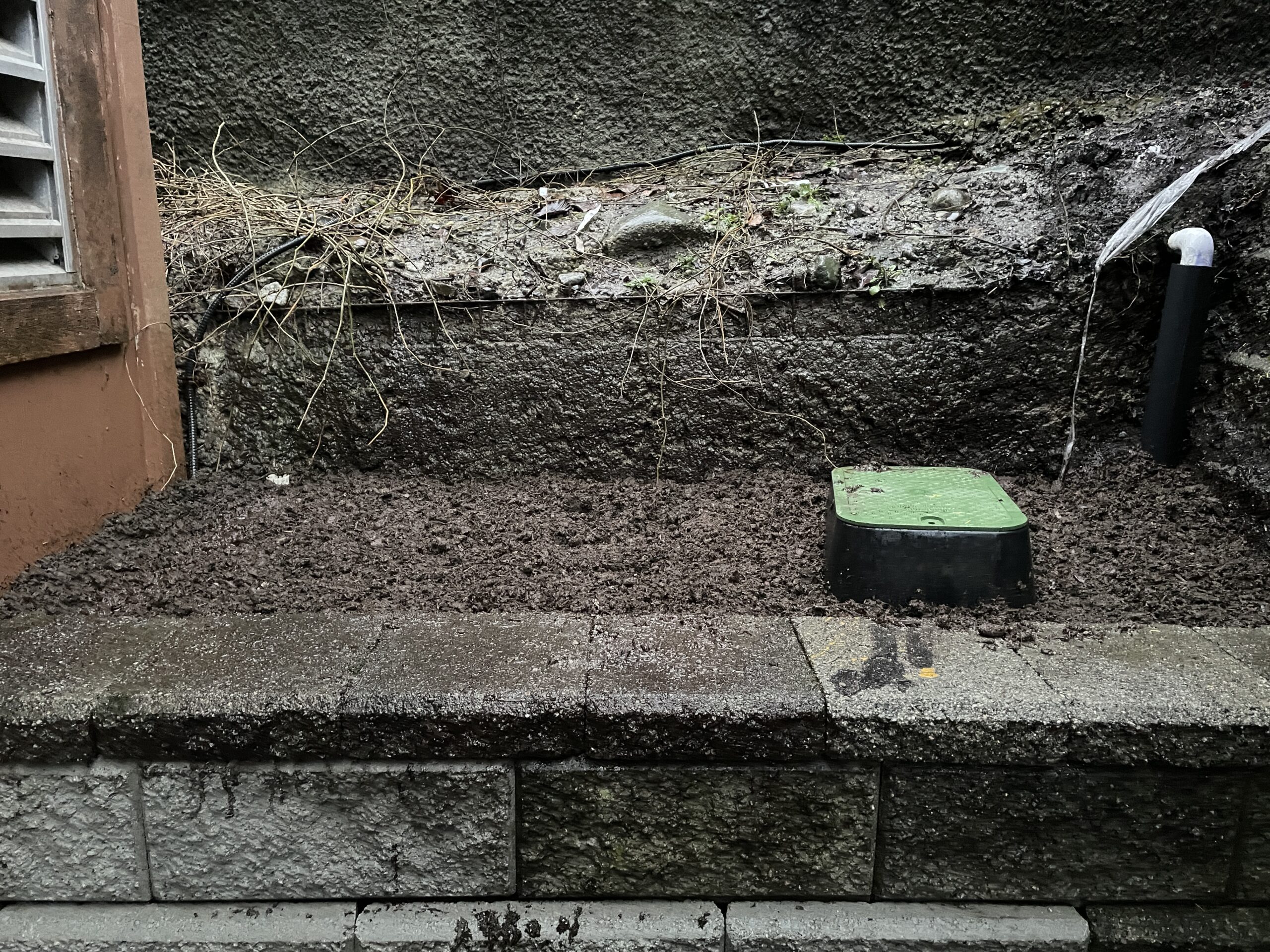

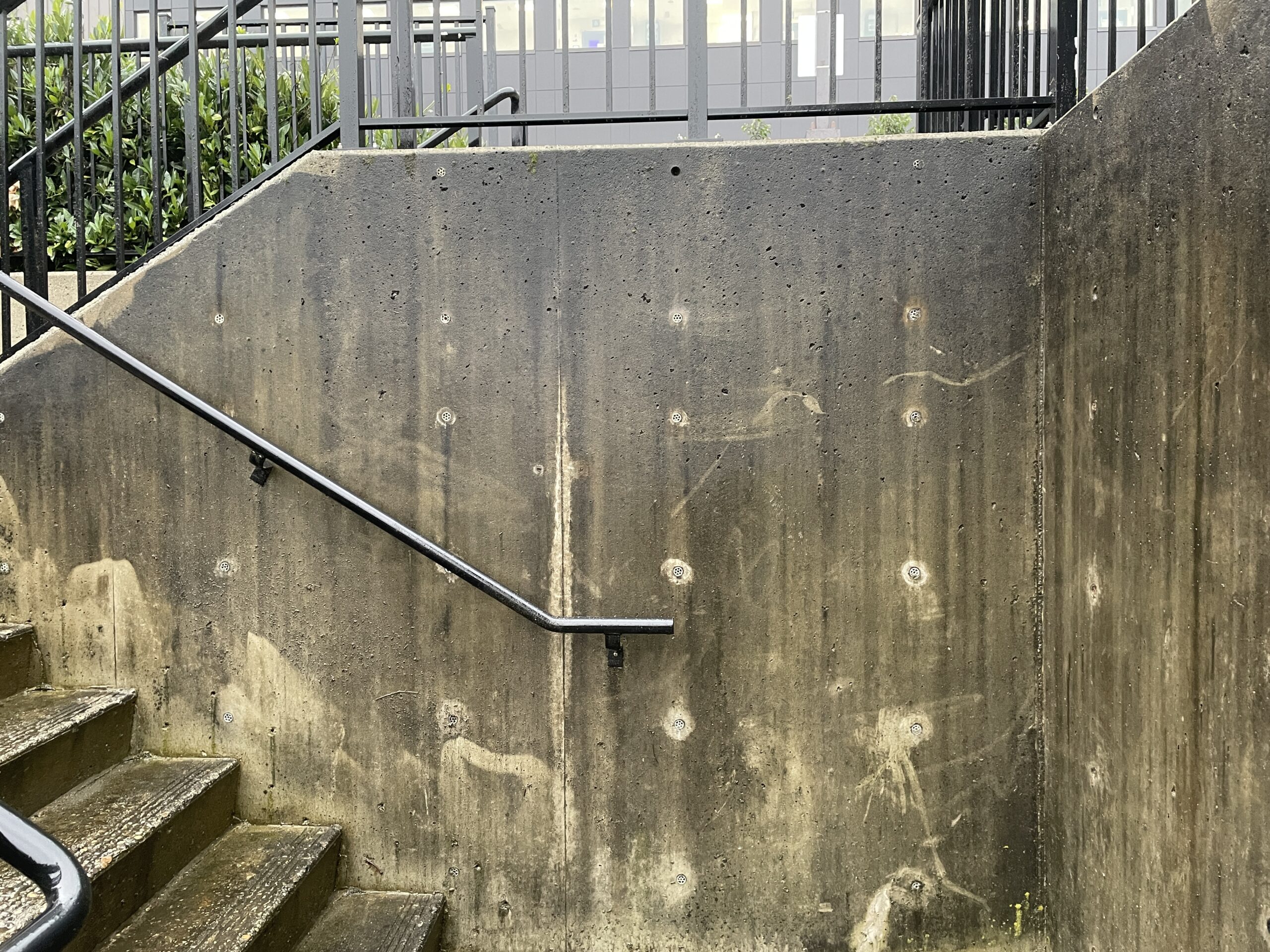

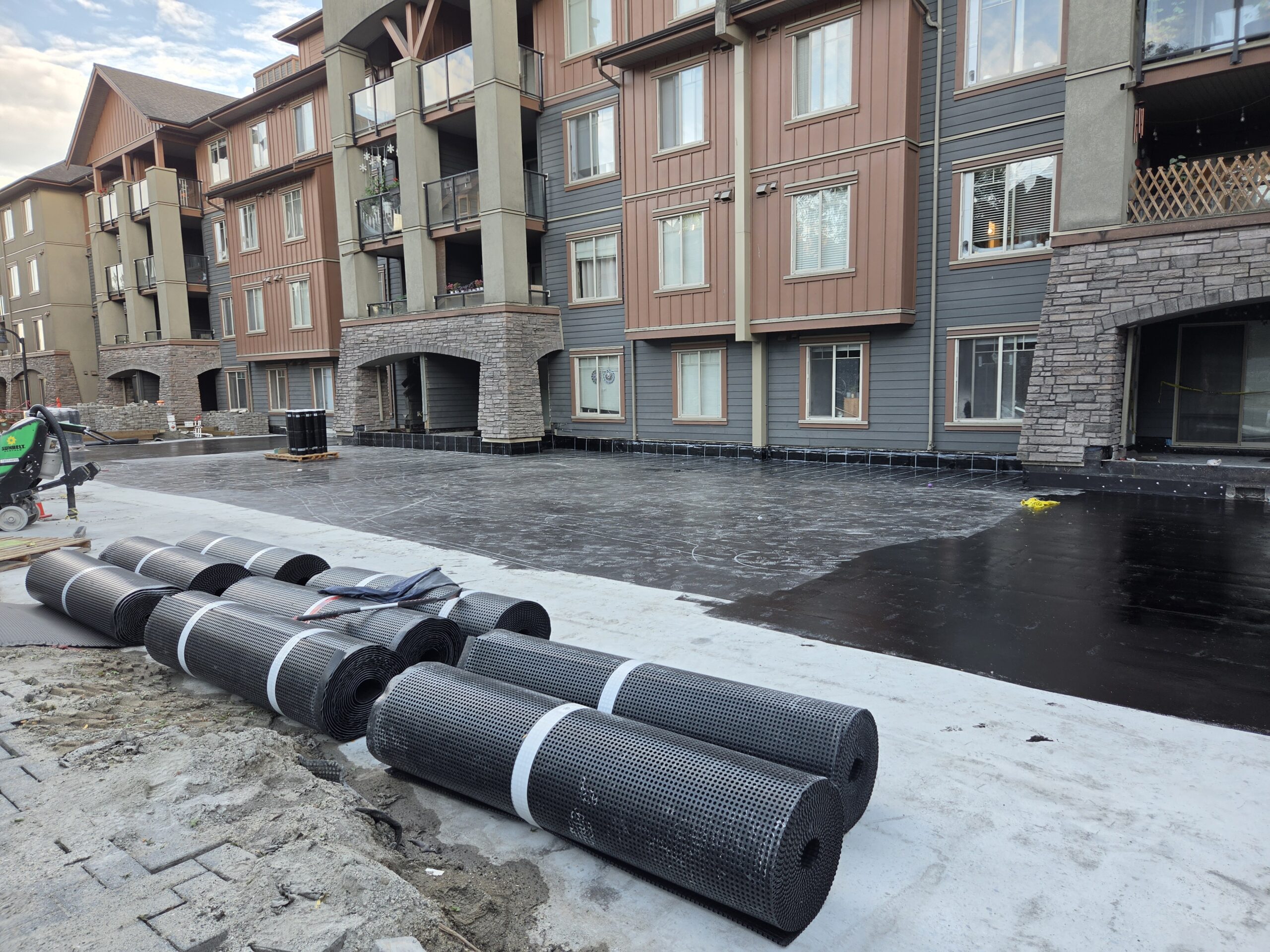

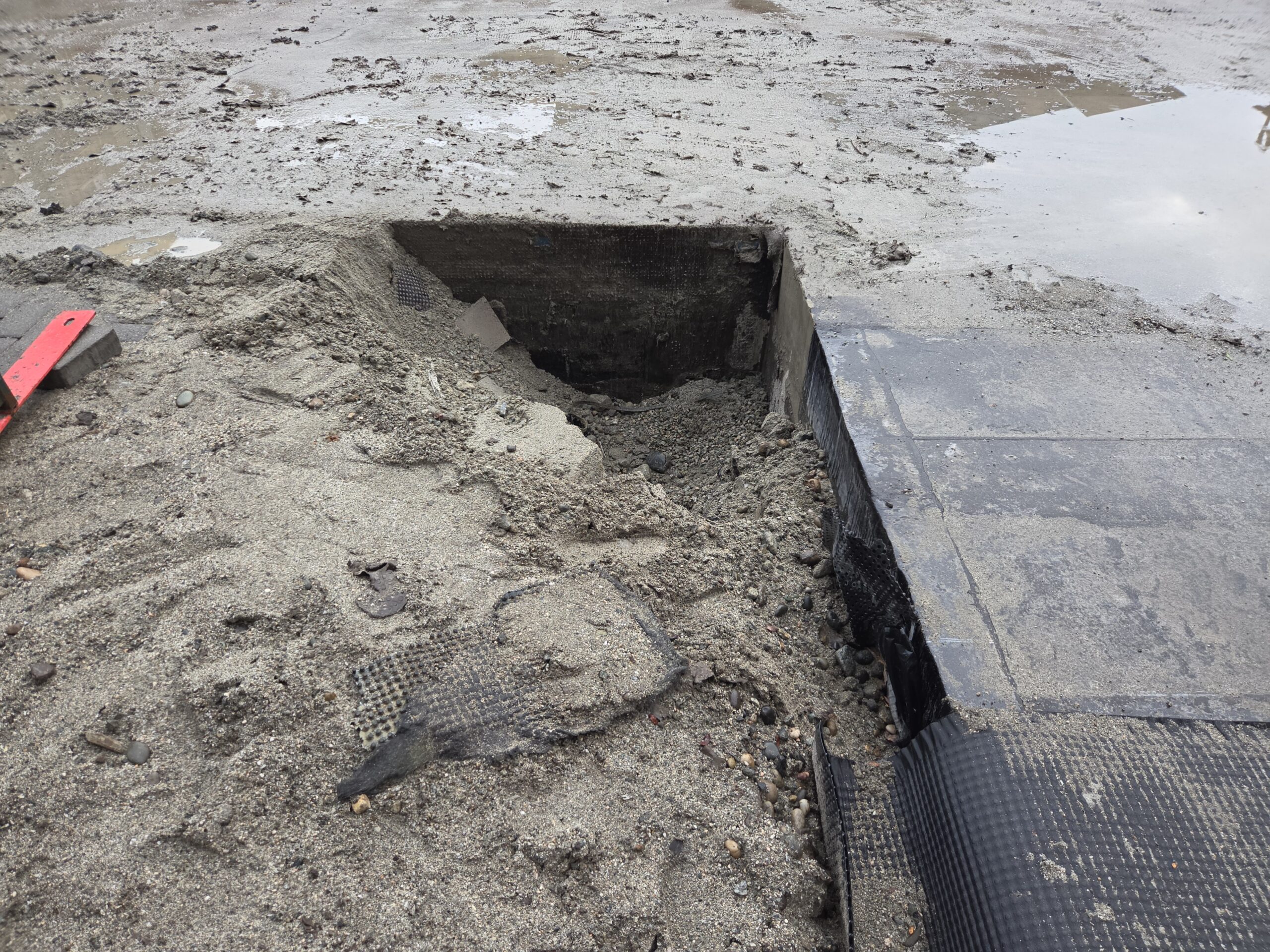

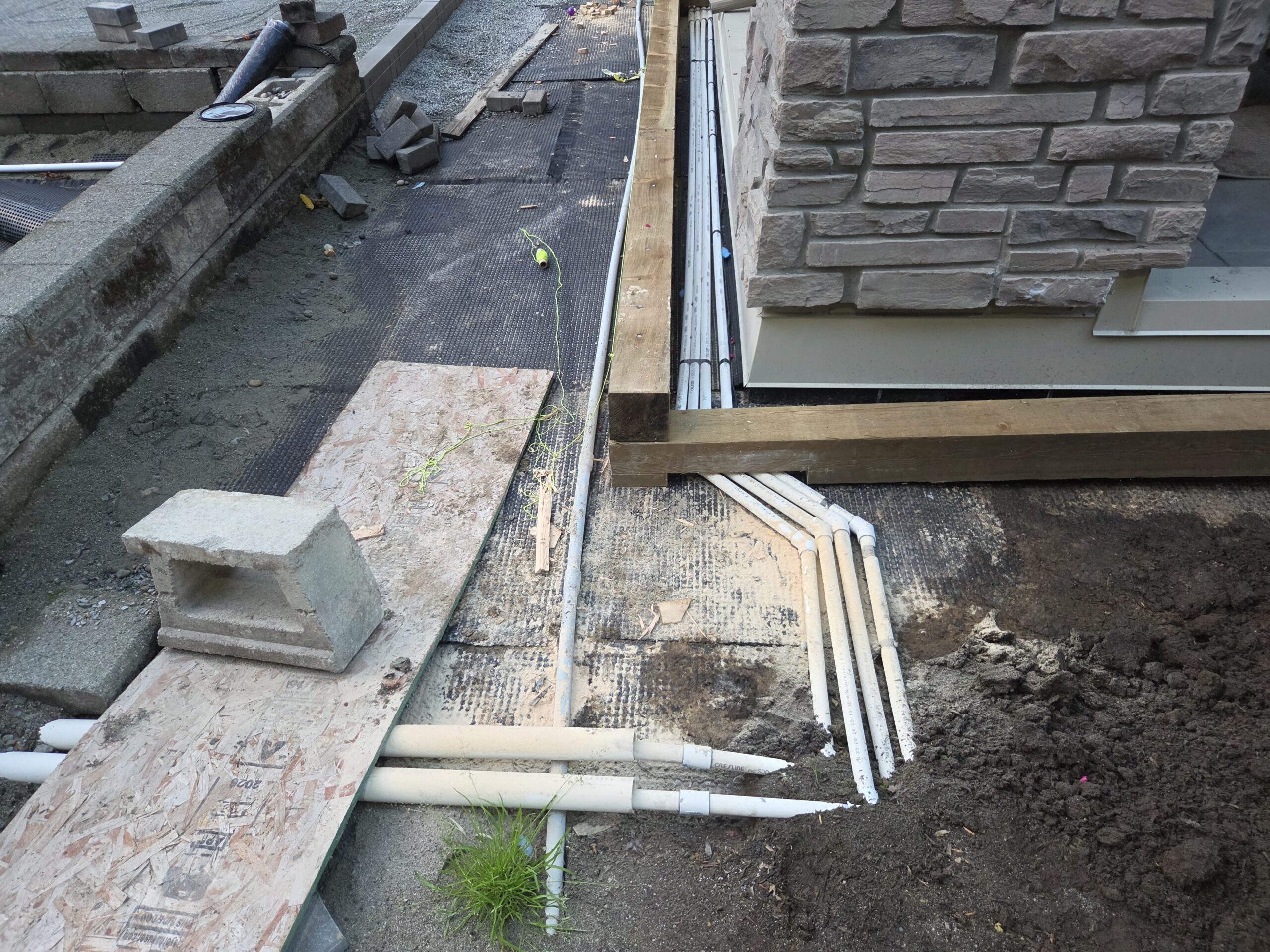

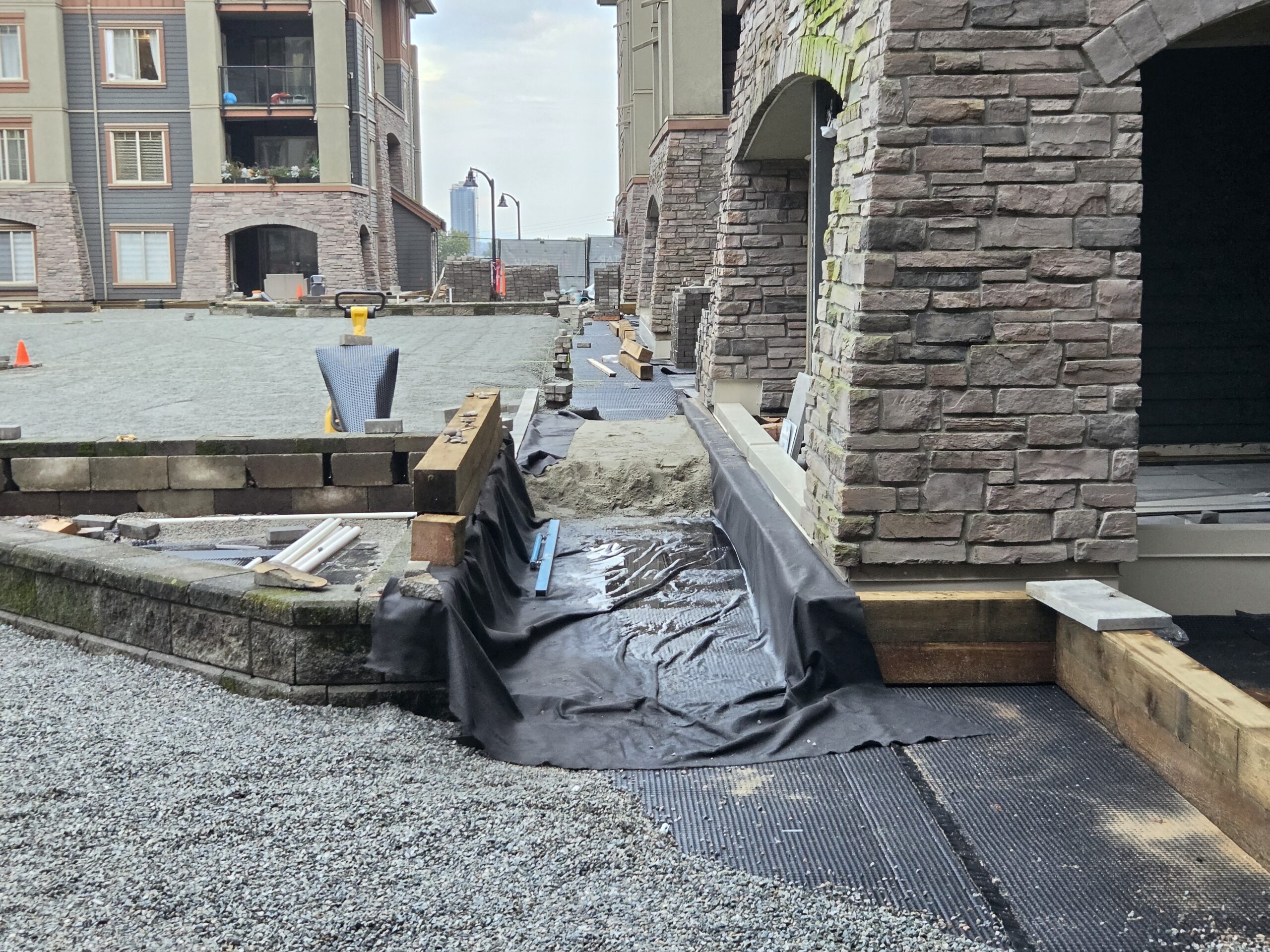

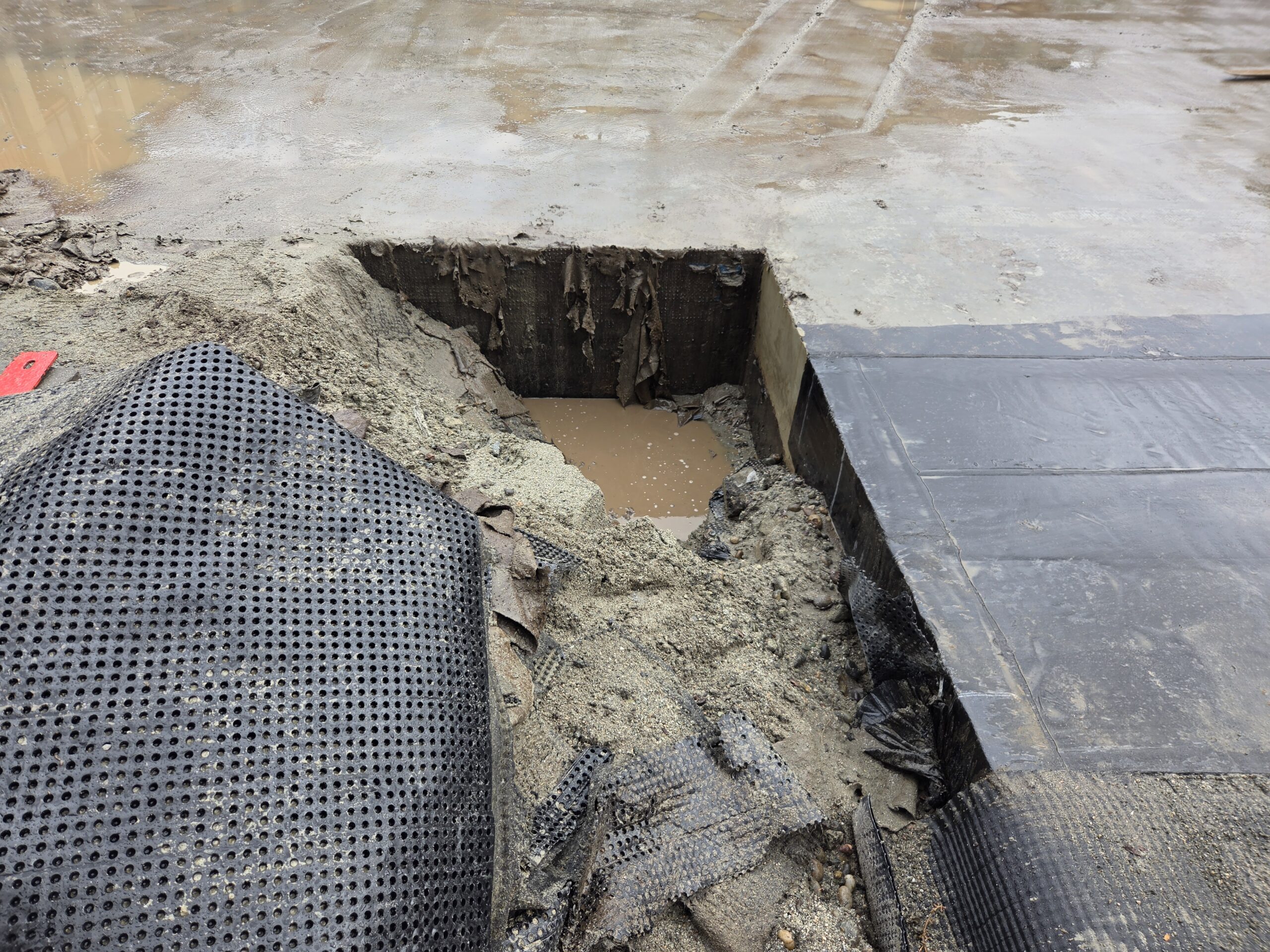

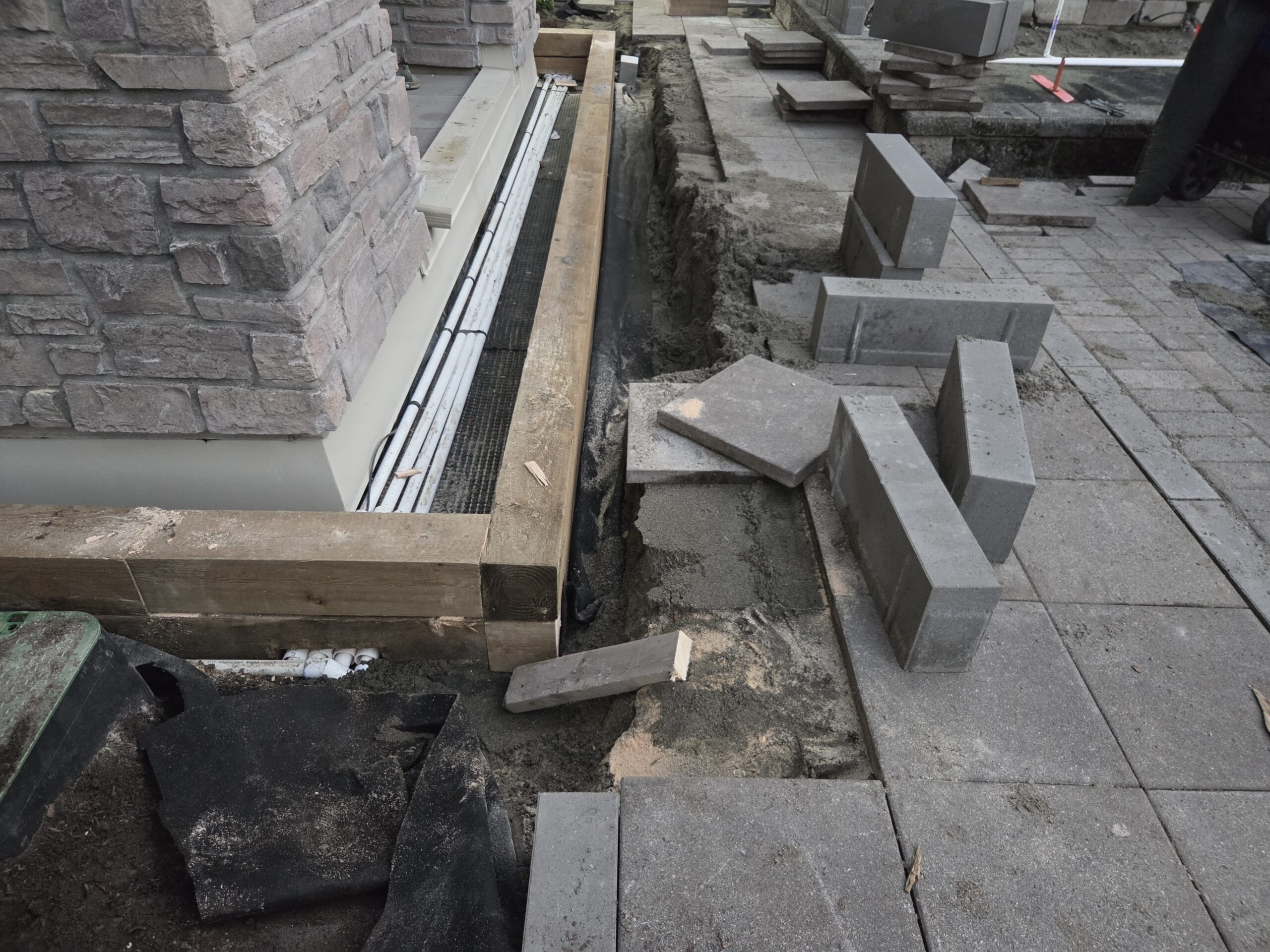

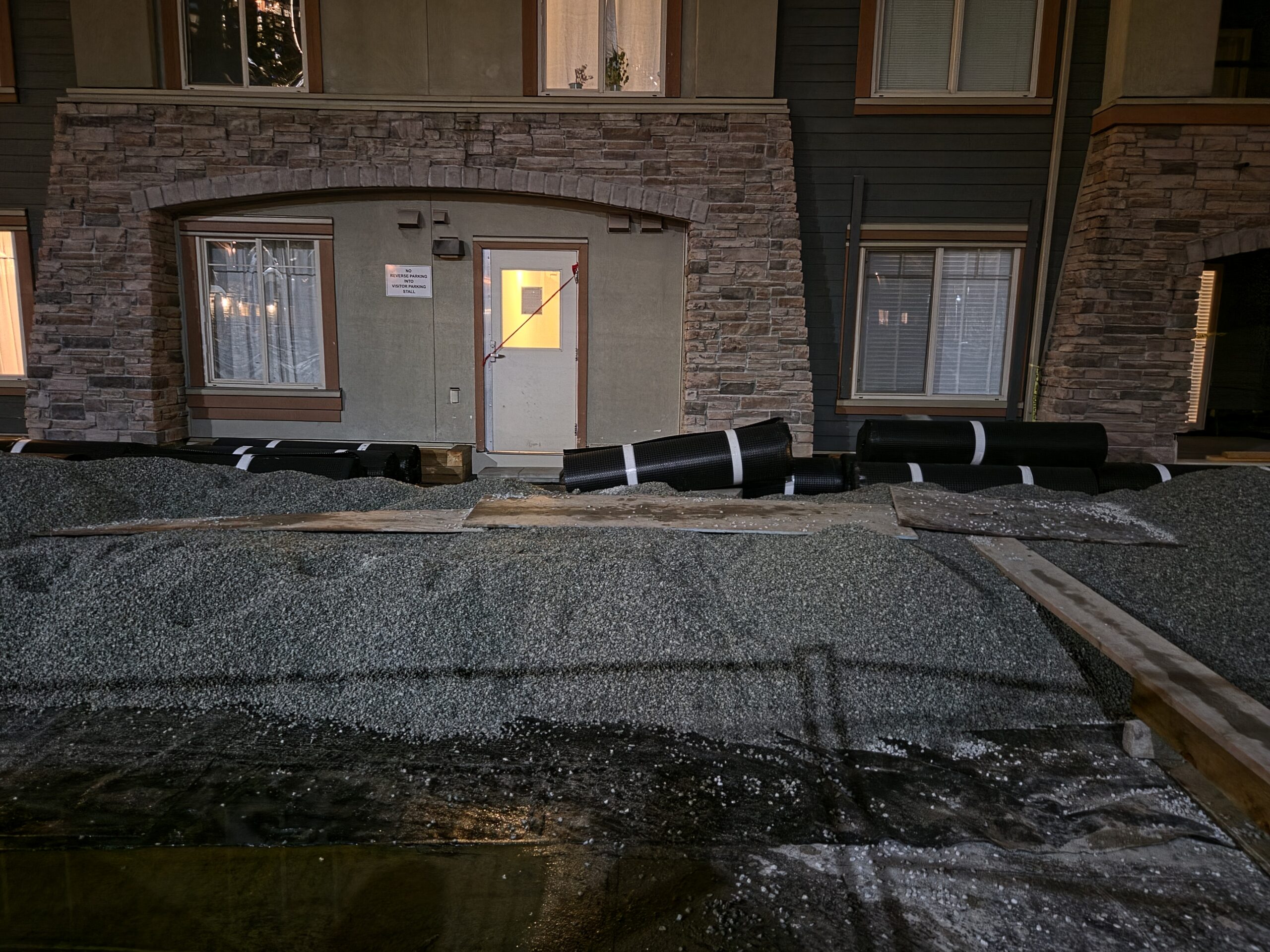

Note in the photo below, the filter fabric and gravel do not extend to the lower left as that area will have soil/vegetation, as it did before.

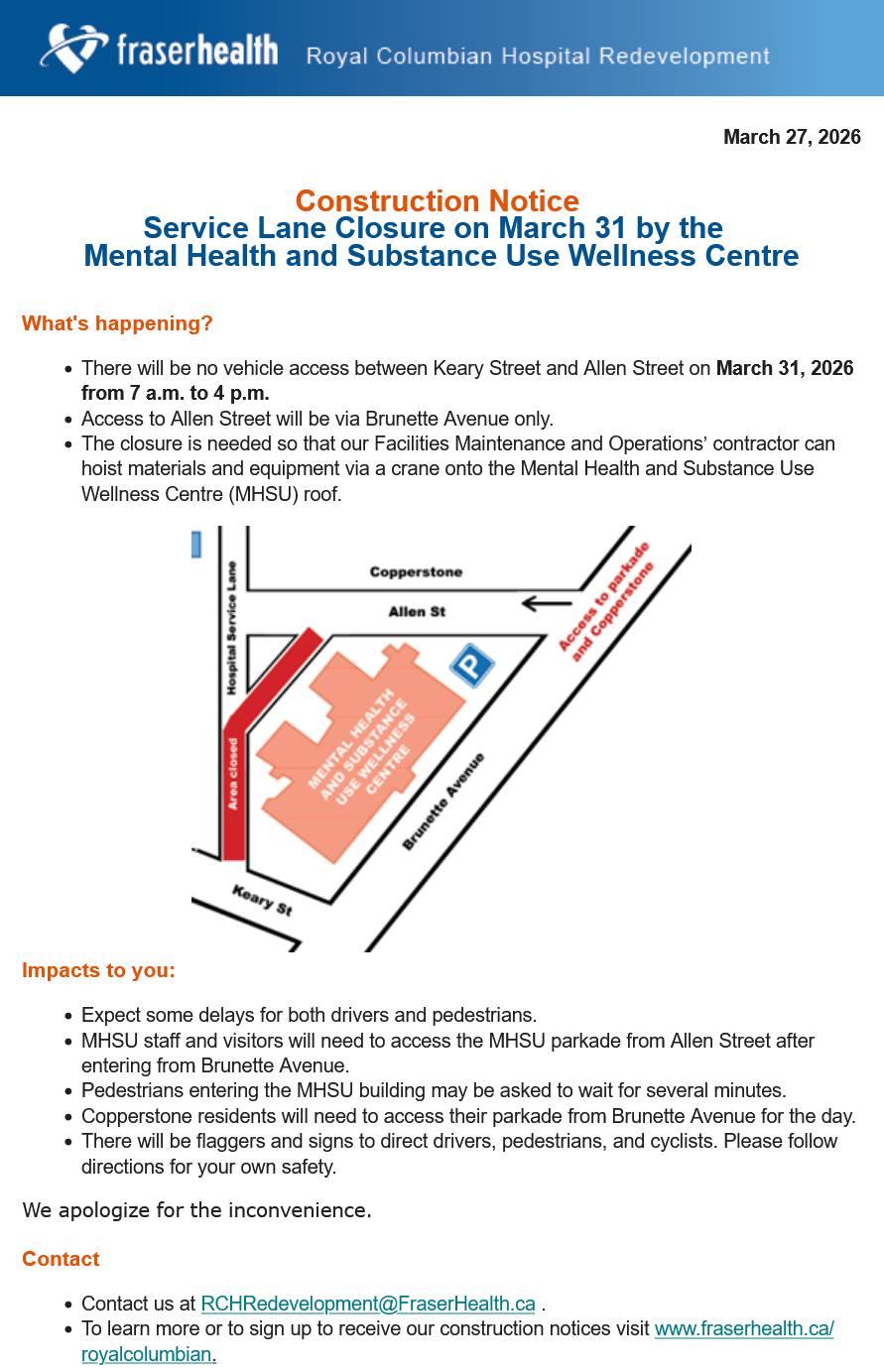

More drain coring on Friday, Nov. 27, 2026–check if you’re affected!

Due to mechanical issues, the contractor working with Prostar was unable to complete coring of all the drains this past Thursday and Friday. Unfortunately, this means that some owners will have to move their vehicles again on Friday, November 27, 2026, to allow the work to be completed.

Note that Copperstone Council does not control the schedule for this work and sends out these notices as soon as they get them.

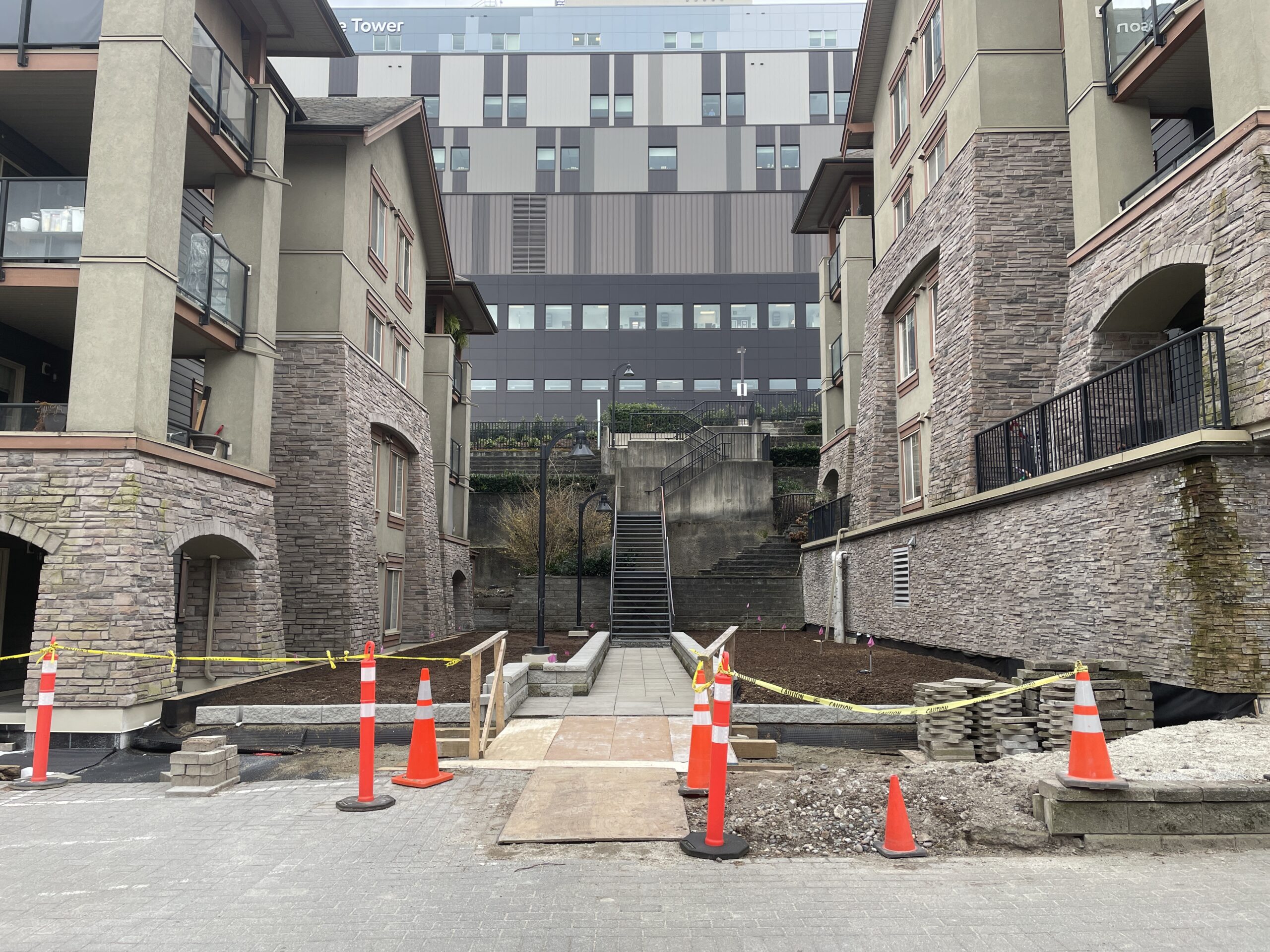

Check the notice below to see if your parking stall is affected.

If you have concerns or questions, contact manager.copperstone@quaypacific.com.

Phase 2 membrane project, Day 102–November 23, 2026

Phase 2 Membrane Replacement Project

Project Mobilization Date: July 20, 2026
Work Start Date: May 4, 2026 (for emergency repairs)
Expected completion: December 2026
Primary contractor: Prostar
Engineering design: Strata Engineering

Weather: 9°C, cloudy, early showers
Workers onsite: At least 4

Work done today:

  • Pavers cleaned
  • Some filter fabric laid at Building 240 entrance, in preparation for gravel/substrate and paver reinstatement
